Please login to bookmark Close

TEPCO BESS Strategy: 2 MW NTT Project, 420 MW Wind EIA, and 20-Year Data Center Agreement (2025)

BESS Adoption in Japan, TEPCO’s Foundational 2 MW Pilot and Strategic Alliances

Tokyo Electric Power Company (TEPCO) shifted its energy storage strategy in 2025 from planning to tangible, foundational execution, establishing a series of pilot projects and commercial agreements that set the stage for future large-scale deployment. While its activities lack the gigawatt-scale announcements of global competitors, TEPCO’s focus on demonstration projects, strategic partnerships, and long-term clean energy contracts signals a deliberate approach to building operational capabilities and de-risking its entry into Japan’s rapidly expanding storage market.

TEPCO’s First Grid-Scale BESS

The most significant milestone in 2025 was the commissioning of the Tsumagoi Power Storage Station, a 2 MW / 9.3 MWh grid-scale Battery Energy Storage System (BESS). This project, developed through a joint venture with NTT Anode Energy, represents TEPCO’s first major operational foray into large-scale battery storage. It serves as a critical test bed for managing grid stability, integrating renewable energy sources, and developing the technical expertise required for future, larger deployments. Prior to 2025, TEPCO’s involvement was largely in planning and R&D, making this operational asset a key strategic step.

Diversification into Hydrogen Storage

TEPCO also expanded its definition of energy storage beyond batteries by partnering with Suntory to demonstrate a large-scale Power-to-Gas (P 2 G) system. This initiative uses surplus renewable electricity to produce green hydrogen, providing another vector for long-duration storage and decarbonization. This move indicates a strategy to build a portfolio of storage technologies, addressing different grid needs and hedging against the limitations of a single solution. This project, alongside a broader focus on carbon capture, recycling, and storage technologies, shows an integrated approach to managing the entire energy lifecycle.

Enabling Future Storage Demand

Commercial agreements signed in 2025 create a clear future demand for TEPCO’s storage capacity. On October 11, 2025, the company announced a 20-year clean energy supply agreement for data centers, a sector that requires exceptionally high levels of power reliability. Fulfilling this long-term contract with intermittent renewables will necessitate significant BESS capacity. Similarly, the company initiated an Environmental Impact Assessment (EIA) for a 420 MW offshore wind project, a generating asset that will require substantial storage to integrate its output into the grid effectively.

Global Energy Storage Market Size and Growth Projections (2025-2035)
Forecast Provider Market Segment 2025 Market Size ($B) 2026 Market Size ($B) 2030 Forecast ($B) 2033/2034/2035 Forecast ($B) CAGR (%) Source
Fairfield Market Research Battery Energy Storage System 66.02 * 74.60 126.91 * 170.10 13 Battery Energy Storage System Market Size, Share, Growth
MarketsandMarkets Battery Energy Storage System 50.81 58.85 * 105.96 220.83 * 15.82 * Top Companies List of Battery Energy Storage System Industry
Future Market Insights Stationary Battery Storage 24.30 27.09 * 42.45 * 72.20 11.50 Stationary Battery Storage Market | Global Market Analysis Report
360iResearch Battery Energy Storage Systems (BESS) 10.15 * 12.79 32.76 * 102.34 25.99 Battery Energy Storage Systems (BESS) Market Trend & Growth
Research Nester Energy Storage 19.74 22.43 * 41.50 * 78.51 * 13.60 Energy Storage Market Size, Share & Growth Forecast to 2035
Market Research Intellect Utility-scale BESS 3.84 4.61 * 9.55 * 23.78 20 Global Utility-scale Battery Energy Storage Systems Market …
IMARC Group India BESS 0.33 0.41 * 1.25 * 2.68 25 India Battery Energy Storage Systems Market Size | 2034
iMissing data has been automatically filled using calculation methods (e.g., CAGR projections derived from a source’s own reported values). Calculated values are displayed in blue * — hover any value to see the formula used.

TEPCO’s 3 Key Partnerships in 2025, from BESS to Green Hydrogen and Offshore Wind

TEPCO’s 2025 strategy heavily utilized partnerships to gain access to new technologies, share financial risk, and build capabilities across the clean energy spectrum. Instead of pursuing large-scale solo ventures, the company formed targeted alliances to execute pilot projects in BESS, green hydrogen, and floating offshore wind, accelerating its learning curve while minimizing capital exposure.

BESS and Green Hydrogen Alliances

The company’s most direct battery initiative, the Tsumagoi BESS, was a joint venture with NTT Anode Energy. This collaboration allowed TEPCO to enter the operational grid-scale storage market with an experienced partner. Its partnership with Suntory for the Power-to-Gas demonstration serves a similar purpose, leveraging a major industrial energy user to pilot green hydrogen production and storage, a critical technology for decarbonizing industrial processes.

Offshore Wind Consortium

Through its subsidiary, TEPCO Renewables, the company joined a consortium with Shell and RWE to commission the Tetra Spar floating offshore wind project. While not a direct battery project, involvement in floating wind is intrinsically linked to energy storage. The intermittent nature of offshore wind requires robust storage solutions to ensure grid stability, and this partnership provides TEPCO with crucial experience in a key renewable sector that will drive future storage demand.

Table: TEPCO Strategic Partnerships and Projects (2025)

Partner / Project Time Frame Details and Strategic Purpose Source
NTT Anode Energy May 2025 Commissioned the 2 MW / 9.3 MWh Tsumagoi Power Storage Station. TEPCO’s first grid-scale BESS provides operational experience in managing battery assets and grid integration. Japan Energy Hub
Suntory Jul 2025 Announced a demonstration of a large-scale Power-to-Gas (P 2 G) system for green hydrogen production. Explores non-battery energy storage vectors for industrial decarbonization. TEPCO
Shell, RWE Jan 2025 TEPCO Renewables participated in the commissioning of the Tetra Spar floating offshore wind project. Gains experience in a key renewable sector that will require future energy storage. Electricals Informed
Data Center Operator(s) Oct 2025 Signed a 20-year agreement to supply clean energy to data centers. Creates a long-term offtake that necessitates firm, dispatchable power, a key driver for BESS. TEPCO
TEPCO Energy Storage and Clean Energy Partnerships (2025)
Date Partner(s) Market Segment Partnership Type Key Details / Objective Source
Oct 11, 2025 Suntory Green Hydrogen / Power-to-Gas Technology Demonstration Commenced a demonstration experiment for an energy demand conversion project using Japan's largest Power-to-Gas (P2G) system to introduce green hydrogen at two Suntory plants. Press Releases 2025 | TEPCO
May 15, 2025 NTT Anode Energy Grid-Scale Battery Storage Joint Project Commissioning Jointly commissioned the 2MW/9.3MWh Tsumagoi Power Storage Station in Gunma Prefecture, marking TEPCO's first operational grid-scale BESS project. TEPCO commissions first grid-scale BESS through joint 2MW …
Jan 30, 2025 Shell, RWE, Stiesdal Offshore Technologies Floating Offshore Wind Project Consortium TEPCO Renewables, as part of the consortium, safely deployed and commissioned the TetraSpar floating foundation demonstrator project. Gibraltar Electrical Industry News

Japan vs Global Markets, TEPCO’s Domestic Challenges and International Expertise

TEPCO’s 2025 energy storage activities were shaped by a fundamental contrast between the immense potential of its domestic market and the significant structural barriers that constrain rapid deployment. While Japan is projected to be one of the world’s fastest-growing BESS markets, TEPCO must navigate unique infrastructure challenges, even as it successfully exports its advanced grid planning expertise abroad.

Japan’s BESS Market Opportunity

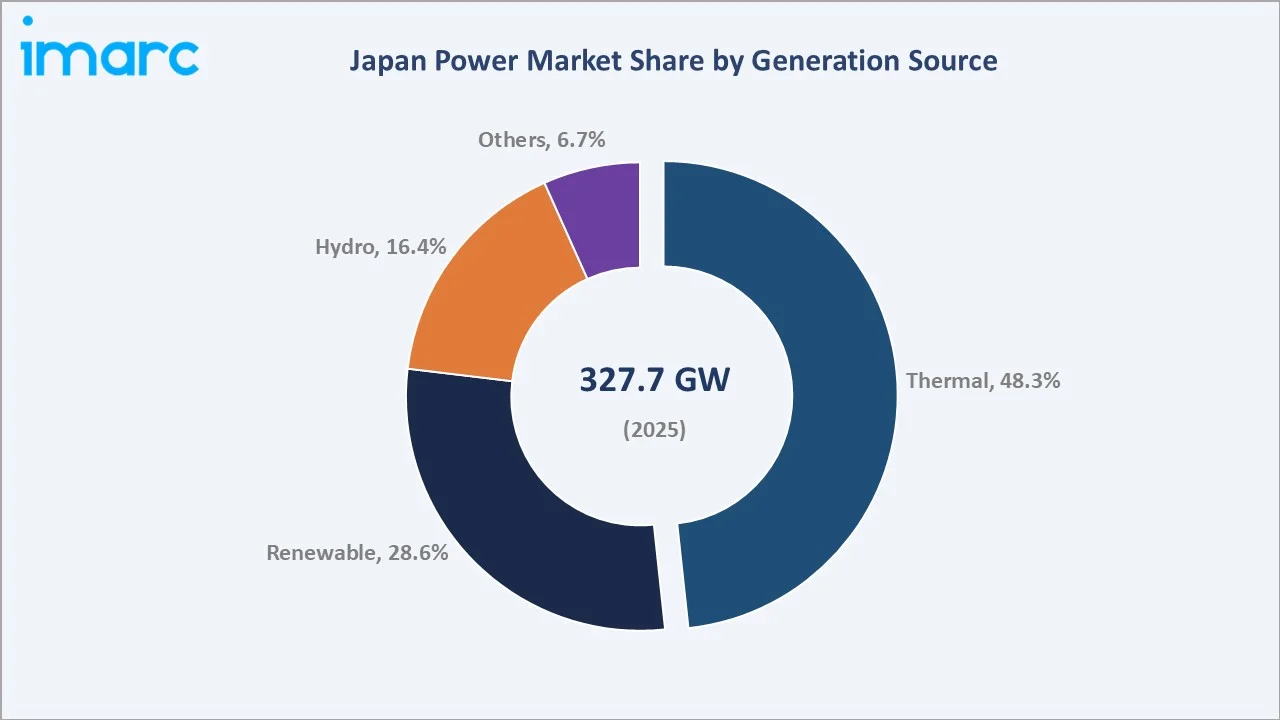

Japan’s installed BESS capacity is projected to expand significantly, reaching between 14.1 GWh and 23.8 GWh by 2030. This growth is driven by national decarbonization goals under Japan’s Strategic Energy Plan and the need to manage output from solar and wind. This creates a substantial domestic opportunity for TEPCO. However, as of September 2025, Japan’s installed capacity was far behind global leaders like China (75 GW) and the U.S. (26 GW), highlighting the scale of the task ahead.

Domestic Grid Constraints

A primary obstacle for TEPCO and other Japanese utilities is the nation’s split grid infrastructure, which operates on different frequencies in the eastern and western regions. This historical division complicates and slows the rollout of large-scale, interconnected energy storage projects, creating “deep structural headwinds” that are not present in more unified grid systems. Overcoming this fragmentation is a key challenge for unlocking the full potential of BESS in Japan.

Exporting Grid Modernization Skills

Despite its domestic challenges, TEPCO demonstrated world-class technical leadership in 2025. TEPCO Power Grid conducted a detailed analysis for the Baltic States on the technical and economic measures needed to achieve 100% renewable electricity generation by 2050. This project showcases TEPCO’s advanced capabilities in planning for high-penetration renewable grids, a skill set developed to manage Japan’s complex system that is now a valuable export. This expertise is directly applicable to its own domestic energy storage and grid modernization strategy.

SWOT Analysis of TEPCO’s 2025 Energy Storage Strategy and Market Position

TEPCO’s 2025 activities highlight a utility with deep technical expertise and strategic partnerships, yet one that remains in the early stages of commercial BESS deployment compared to global peers. The company’s strengths in grid management and its position within a high-growth domestic market provide a strong foundation, but it faces threats from faster-moving international competitors and significant domestic infrastructure hurdles.

Table: SWOT Analysis for TEPCO’s Energy Storage Initiatives

SWOT Category Pre-2025 Status 2025 Activity & Status What Changed / Validated
Strengths Extensive grid management experience; strong R&D capabilities; established market position as a major Japanese utility; JERA joint venture for fuel procurement. Demonstrated advanced grid planning expertise in a consulting project for the Baltic States; secured a 20-year clean energy PPA for data centers. TEPCO validated its ability to monetize its technical expertise internationally and secure long-term contracts that create a clear business case for future storage investments.
Weaknesses Lack of operational experience with large-scale BESS projects; deployments lagging behind global utility peers. Commissioned its first grid-scale BESS, but at a small pilot scale (2 MW / 9.3 MWh); still significantly behind competitors like Next Era Energy in deployed capacity. The company began to address its operational experience gap, but the small scale of the Tsumagoi pilot confirms it is still in a learning phase rather than a mass-deployment phase.
Opportunities Japan’s national energy policies supporting renewables and storage; growing demand for grid stabilization services. Japan’s BESS market projected to reach up to 23.8 GWh by 2030; global battery costs fell by 40%, with kit prices starting at US$200/k Wh. The economic and market case for BESS in Japan strengthened significantly in 2025, validating the strategic importance of TEPCO’s pilot projects as a precursor to larger investments.
Threats Competition from domestic and international energy companies; structural grid limitations in Japan. Japan’s split-frequency grid remains a “deep structural headwind” slowing large-scale rollouts; global competitors in the U.S. and China are deploying tens of gigawatts. The scale of international deployment validated the threat of being left behind, while domestic infrastructure issues were confirmed as a persistent, near-term obstacle to rapid growth.
TEPCO Commercial Agreements and Projects (2025)
Date Project / Agreement Market Segment Location / Counterparty Capacity / Details Status Source
Oct 11, 2025 Clean Energy Supply Agreement Power Purchase Agreement Data Centers (unspecified) 20-year agreement to supply clean energy. Agreement Signed Press Release | TEPCO 2025
Oct 11, 2025 Green Hydrogen Demonstration Power-to-Gas Suntory Plants, Japan Japan's largest P2G system for energy demand conversion. Demonstration Commenced Press Releases 2025 | TEPCO
May 15, 2025 Tsumagoi Power Storage Station Grid-Scale BESS Gunma Prefecture, Japan 2 MW / 9.3 MWh capacity. Joint project with NTT Anode Energy. Commissioned TEPCO commissions first grid-scale BESS through joint 2MW …
Mar 27, 2025 Offshore Wind Project EIA Offshore Wind Offshore Japan 420 MW planned capacity. EIA Started Vindr secures rights to develop 600 MW of onshore wind in Latvia
Jan 30, 2025 TetraSpar Floating Wind Project Floating Offshore Wind Demonstrator project with partners Shell, RWE, and Stiesdal. Commissioned Gibraltar Electrical Industry News
iBlank cells indicate the underlying source did not report a value for that column.

14.1 GWh Market Opportunity, TEPCO’s Next Steps for BESS Deployment

With foundational projects now active, TEPCO’s critical next step is to translate the operational learnings from its 2025 pilots into a strategy for large-scale commercial deployment to capture a meaningful share of Japan’s multi-gigawatt-hour market opportunity. The success of this transition will depend on its ability to leverage its partnerships and technical expertise to overcome domestic grid constraints and secure financing for larger capital projects.

  • If TEPCO successfully leverages its Tsumagoi BESS pilot, watch for announcements in 2026-2027 for follow-on projects in the 100+ MW range. These projects would likely be linked to supporting its new long-term PPAs, such as the 20-year data center supply agreement, or its planned 420 MW offshore wind farm.
  • These developments could be happening now: TEPCO is likely using the operational data from the 2 MW Tsumagoi station to build the economic models and technical specifications for larger BESS installations. The company’s confirmed intent to “invest in our capabilities in new energy storage solutions” suggests that internal capital allocation processes for these larger projects are underway.
  • A key signal will be the expansion of its partnership with NTT Anode Energy or the formation of new joint ventures with major battery manufacturers or project developers. A move to secure a large volume of batteries or form a development consortium would indicate a shift from piloting to a commercial deployment strategy.
TEPCO and Competitor Clean Energy Investments and Projects (2025)
Date Company Market Segment Project / Investment Location Investment Value / Capacity Key Outcome / Status Source
Dec 15, 2025 Ford Battery Storage New Battery Storage Business Approx. $2 billion over the next two years Announced the formation of a new business unit to power data centers and the grid. Ford is starting a battery storage business to power data …
May 15, 2025 TEPCO Grid-Scale Battery Storage Tsumagoi Power Storage Station Gunma Prefecture, Japan 2 MW / 9.3 MWh Project commissioned and operational. TEPCO commissions first grid-scale BESS through joint 2MW …
Mar 27, 2025 TEPCO Offshore Wind Offshore Wind Project Offshore Japan 420 MW Environmental Impact Assessment (EIA) started. Vindr secures rights to develop 600 MW of onshore wind in Latvia
Mar 26, 2025 Toyota Stationary Battery Storage BESS Demonstration for STM Plant 0.63 MWh Demonstration project providing clean electricity and energy management. Demonstration of Stationary Battery Energy Storage System (BESS …
iBlank cells indicate the underlying source did not report a value for that column.
