T 1 Energy Data Center Power, 50 MW Statnett Allocation, and 50% Global Project Delay Rate (2021 to 2026)

AI Data Center Power Constraints, T 1 Energy Signals Shift to Secondary Markets

The primary factor limiting AI infrastructure growth has shifted from capital access to power availability, forcing developers to abandon oversaturated primary markets for secondary locations with accessible grid capacity. Before 2025, data center development was concentrated in established hubs like Northern Virginia, where power was a presumed commodity. Today, surging energy requirements for AI have overwhelmed these legacy locations, creating a new strategic imperative to secure power first. T 1 Energy’s successful 50 MW allocation in Norway exemplifies this pivot, de-risking its project by locking in power where it is abundant, while competitors face extensive delays in traditional markets.

From Hub Concentration to Power Migration

The operational model for data center site selection has inverted in the last two years, moving from a location-first to a power-first strategy. This change is a direct response to grid limitations becoming the most significant impediment to development.

  • Between 2021 and 2024, developers prioritized proximity to major population centers and fiber networks, with Northern Virginia being the global epicenter. Power procurement was a downstream step in the development process, and utilities like Dominion Energy were expected to meet demand.
  • Starting in 2025, this model became untenable. Reports indicate that between 30% and 50% of planned 2026 data center projects globally face significant delays or cancellation specifically due to the inability to secure a grid connection. The total US interconnection queue now stands at over 2, 600 GW, with AI projects representing a substantial portion.
  • T 1 Energy’s March 2026 agreement with Norway’s grid operator, Statnett, for a 50 MW block of near-100% hydropower demonstrates the new winning formula: developers are now migrating to where the power is, fundamentally altering the geographic map of digital infrastructure.

Hardware Demands Outpace Grid Supply

The technical requirements of AI hardware have created a step-change in energy consumption that existing grid infrastructure cannot support. The industry’s move toward higher-density computing has rendered many traditional data center locations obsolete from a power perspective.

  • Prior to 2024, average rack power densities were in the range of 10 k W to 20 k W. This allowed for predictable, incremental growth that grids in markets like Virginia and Silicon Valley could accommodate with sufficient planning.
  • By 2026, rack power densities for AI workloads frequently exceed 50 k W, with some projections approaching 100 k W. This exponential increase means a single facility can now require the power equivalent of a small city, a demand that far outstrips available capacity in many developed areas.
  • This hardware evolution forces a strategic response, including moving to new geographies as T 1 Energy has done, or exploring grid-free energy solutions. On-site generation, such as SOFC systems from providers like Bloom Energy, is increasingly being considered to bypass grid connection challenges entirely.
Project Comparison: T1 Energy Mo i Rana vs. Typical 2026 AI Hyperscale Data Center
Metric T1 Energy Mo i Rana Project Typical New AI Hyperscale Data Center Source
Power Capacity (MW) 50 100–750 AI Data Center Power Requirements 2026: The Grid-to-Chip …
Power Source Near-100% Hydropower Grid Mix (often includes fossil fuels), supplemented by PPAs T1 Energy secures 50MW grid power for Nordic data center
Location Mo i Rana, Norway Established hubs (e.g., Northern Virginia) or emerging secondary markets T1 Energy secures 50MW grid connection for former …
Size (sq. ft.) 926000 Variable (often 1,000,000+)
Key Advantage Secured, low-cost renewable power in a supply-constrained market Proximity to fiber networks and population centers
Key Challenge Temporary (2027-2033) power allocation requires long-term solution Securing grid interconnection; project delays due to power scarcity Will T1 Energy’s (TE) 50MW Mo i Rana Boost Reshape Its …
iBlank cells indicate the underlying source did not report a value for that column.
EPOCH AI — AI Data Centers Poised to Exceed Gigawatt Power Threshold by 2026

AI Data Centers Poised to Exceed Gigawatt Power Threshold by 2026
By 2026, five leading AI data centers, including xAI’s Colossus 2 (projected over 1,200 MW) and Anthropic-Amazon’s New Carlisle (projected over 1,000 MW), are set to reach or exceed a gigawatt of power. This monumental surge in demand dwarfs typical 50 MW allocations, indicating a rapid, large-scale shift in energy consumption patterns for advanced AI infrastructure.

(Source: EPOCH AI — via Roadmap: The AI data center stack – Bessemer Venture Partners)

50% Project Delay Rate, T 1 Energy Navigates Global AI Power Impediments

Project delays tied directly to power procurement have become the most significant financial and operational risk in the data center sector, altering investment calculations and favoring developers who can secure power commitments upfront. Reports from early 2026 confirm that up to half of all new data center projects are stalled in grid interconnection queues, creating a clear divide between projects with secured power and those without. T 1 Energy’s allocation provides a crucial proof point that securing power in advance is the most effective way to mitigate this widespread industry risk.

Quantifying the Delay Risk

The scale of project delays has moved from an anecdotal concern to a quantifiable market-wide problem. This has direct implications for construction timelines, capital deployment, and return on investment, making power availability a primary due diligence item for investors.

  • According to a February 2026 analysis by Latitude Media, as many as half of the world’s planned data center projects for the year could be delayed due to power sourcing issues. This follows warnings from major grid operators about multi-year waits for new connections.
  • In the United States, markets like Northern Virginia have seen utilities pause new connections, while states like New York have implemented temporary moratoriums to study the grid impact, adding a layer of policy risk to the operational challenges.
  • This environment of uncertainty penalizes developers who follow traditional build-then-connect models and rewards the strategic foresight of firms like T 1 Energy that lock in power agreements before committing major capital to construction.

Table: Market Signals Highlighting Power-Related Project Risk

Event / Report Time Frame Details and Strategic Purpose Source
New York Data Center Moratorium July 2026 Governor established a temporary moratorium on new and renewed permits for data centers to assess statewide environmental and grid impacts, signaling growing policy risk. NY Governor’s Office
AI Consulting Network Grid Guide April 2026 Published a guide for investors detailing the “power grid crisis, ” advising that grid availability, not land or capital, is the primary constraint for 2026 AI data center development. The AI Consulting Network
Latitude Media Delay Analysis February 2026 Reported that up to 50% of the world’s data center projects slated for 2026 may be delayed or cancelled, citing power unavailability as the leading cause. Latitude Media

T 1 Energy Statnett Allocation Highlights Utility Partnerships for AI Power (2025 to 2026)

The central dynamic in data center development has become the strategic partnership between developers and utility providers. Securing a firm, long-term power allocation from a grid operator is now the most critical prerequisite for a project’s success. The agreement between T 1 Energy and Norway’s Statnett is a clear model for this new paradigm, where collaborative planning with energy suppliers precedes site construction and capital deployment.

The New Partnership Model

Successful data center projects are increasingly defined by the strength of their relationship with power providers. This marks a shift away from the transactional, and often adversarial, process of simply requesting a connection toward a more integrated, long-range planning model.

  • The T 1 Energy deal is not just for a power connection but for a reserved 50 MW capacity block, providing the certainty needed to secure tenants and financing for its Mo i Rana facility. This type of forward commitment from a utility is becoming a prized asset.
  • Hyperscalers are pursuing this strategy at a massive scale. Google’s partnerships with utilities like Next Era Energy for 2.0 GW of power and Ameren for 500 MW illustrate that even the largest tech firms now prioritize securing energy supply through direct utility agreements.
  • Other models include joint ventures, such as the 2 GW “Power Bridge” project from Liberty Energy, which aims to build generation capacity dedicated specifically to data center clients, effectively internalizing the utility partnership.

Table: Illustrative Data Center Power Partnerships

Partners Time Frame Details and Strategic Purpose Source
T 1 Energy / Statnett March 2026 T 1 Energy secured a 50 MW temporary grid allocation from Norway’s state-owned operator for an AI data center in Mo i Rana, leveraging available hydropower to bypass queues in other markets. T 1 Energy

Nordics vs. North America, T 1 Energy’s Strategic Site Selection

The map of AI data center development is being redrawn, with a clear migration from power-constrained hubs in North America to regions with surplus energy, particularly the hydropower-rich Nordics. This geographic diversification is no longer an alternative strategy but a necessary one for survival and growth. T 1 Energy’s choice of Mo i Rana, Norway, is a calculated move that capitalizes on this global shift, trading proximity to established ecosystems for the far more valuable commodity of guaranteed, clean power.

The Push from Saturated Hubs

Traditional data center markets are becoming victims of their own success. Years of concentrated growth have exhausted local grid capacity, leading to development moratoria and intense public scrutiny over resource consumption.

  • Before 2025, Northern Virginia was the undisputed leader, but its primary utility, Dominion Energy, has since warned of multi-year delays for new connections, effectively capping growth in the world’s largest data center market.
  • Growing public and political backlash against the immense water and energy use of data centers is also a factor, as seen in reports from May 2026. This adds regulatory risk to the operational challenges in densely populated areas.

The Pull to Power-Rich Regions

In response, developers are actively seeking new territories where energy is not a constraint. This has put a spotlight on locations that were previously considered secondary or tertiary markets.

  • The Nordic region, with its abundant and low-cost hydropower, has emerged as a prime destination. T 1 Energy’s project taps into this advantage, securing power at stable prices with strong ESG credentials.
  • Other regions like Texas are also seeing intense activity, with developers like Clean Core planning large-scale projects to take advantage of the state’s renewable energy resources and favorable regulatory environment, despite a massive 226 GW interconnection queue in ERCOT.
  • Even within established countries, development is moving. In China, data center clusters are being directed by the state toward western provinces with more energy resources, a trend also driven by grid constraints in eastern economic hubs, as seen with Alibaba’s $6.12 B investment in new clusters.

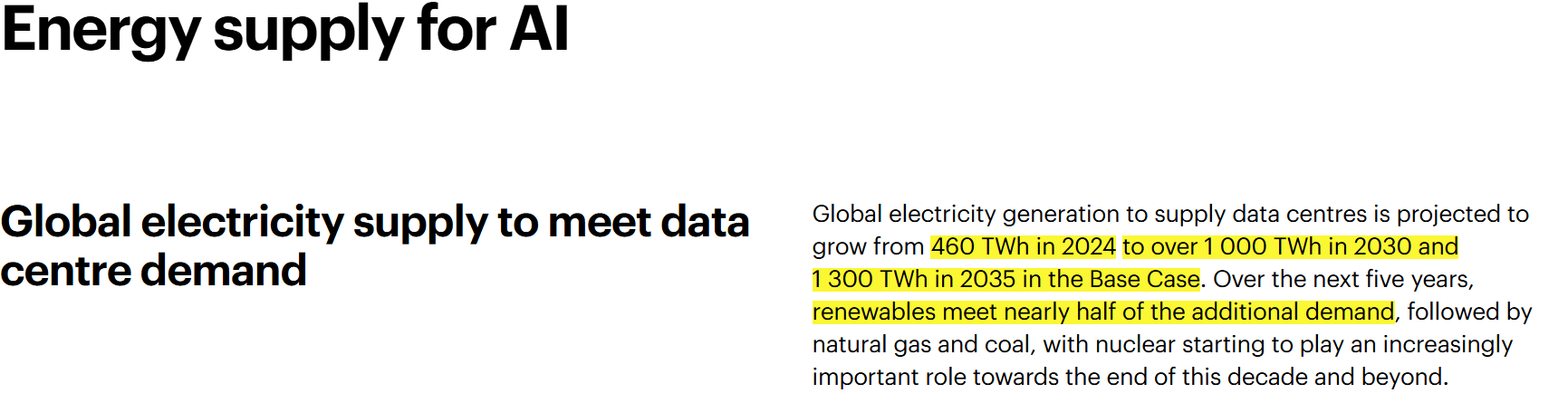

Data Center Electricity Consumption Forecasts
Source Market Segment 2024 (TWh) 2026 (TWh) 2030 (TWh) 2035 (TWh) Source Link
Green Software Foundation Global Data Centers 415 Data Centers as Flexible Grid Participants
IEA (via Brookings) Global Data Centers 709.47 * 780.61 * 945 1200 Global energy demands within the AI regulatory landscape
Brookings Estimate Global Data Centers 1050 Global energy demands within the AI regulatory landscape
iMissing data has been automatically filled using calculation methods (e.g., CAGR projections derived from a source’s own reported values). Calculated values are displayed in blue * — hover any value to see the formula used. Blank cells indicate the underlying source did not report a value for that column, and there was not enough of that source’s own data to calculate one (a growth rate needs at least two reported years).

SWOT Analysis, T 1 Energy’s 50 MW AI Data Center Allocation

T 1 Energy’s strategic position is defined by its successful power procurement, which serves as a major strength and mitigates the primary threat facing the industry. However, the project’s scale presents a weakness, while its location offers both unique opportunities for expansion and potential threats from emerging competition.

Table: SWOT Analysis for T 1 Energy’s Mo i Rana Project

SWOT Category Key Attributes and Dynamics
Strengths
  • Secured Power: The 50 MW allocation from Statnett is a definitive commitment that de-risks the project timeline and budget, a critical advantage when competitors are stalled in queues.
  • Clean Energy Source: Leveraging near-100% hydropower provides price stability and directly addresses tenant ESG mandates, making the site more attractive to premium clients.
  • First-Mover Advantage: Securing a site and power in an emerging Nordic sub-market positions T 1 Energy ahead of a likely wave of competitors.
Weaknesses
  • Modest Scale: While significant, 50 MW is at the low end of the hyperscale range, which can now reach 500 MW to 1 GW. This may limit its appeal to the very largest tenants.
  • Secondary Market Location: Mo i Rana lacks the robust fiber connectivity and skilled labor pool of established hubs like Ashburn or London, which could increase operational costs.
  • Extended Timeline: The power is scheduled to come online between Q 2 2027 and late 2033, a wide and lengthy window that introduces long-term execution risk.
Opportunities
  • Attract Anchor Tenants: The certainty of clean power could attract hyperscalers or AI firms shut out of primary markets, potentially allowing T 1 Energy to command premium lease rates.
  • Campus Expansion: The 926, 000-square-foot facility offers physical space to grow, and this initial allocation could serve as a foothold to secure additional power blocks from Statnett for a larger campus.
  • Blueprint for Replication: Success in Mo i Rana could create a replicable model for identifying and developing sites in other overlooked, power-rich regions globally.
Threats
  • Increased Competition: T 1 Energy’s public success will attract other developers to the Nordics, increasing competition for land, labor, and future power allocations.
  • Regulatory Shift: Norwegian policymakers could re-evaluate energy priorities and impose new taxes or restrictions on data centers as their prevalence grows, similar to trends seen elsewhere.
  • Grid Upgrades in Primary Markets: If utilities like Dominion Energy accelerate grid upgrades faster than expected, the competitive advantage of secondary markets could diminish.
AI Data Center Market Size & Growth Trajectory
Forecast Provider Market Segment 2025 Market Size ($B) 2026 Market Size ($B) 2033/2035 Forecast ($B) CAGR (%) Source
Grand View Research AI Data Center 147.30 180.60 810.60 23.90 AI Data Center Market Size, Growth Report, 2026-2033
Polaris Market Research AI Data Center 145.58 180 * 1216.24 * 23.65 AI Data Center Market Size, Trends and Forecast Report …
Cervicorn Consulting AI Data Center 5.76 6.69 * 25.53 16.08 * AI Data Centre Market Size to Reach USD 25.53 Bn by 2035
iMissing data has been automatically filled using calculation methods (e.g., CAGR projections derived from a source’s own reported values). Calculated values are displayed in blue * — hover any value to see the formula used.

Scenario Modeling, T 1 Energy’s Next Move After Statnett Deal

The most critical variable for T 1 Energy in the next 18 months is its ability to translate the 50 MW power allocation into a fully leased facility with a high-value anchor tenant. This outcome will validate the “migrate-to-power” strategy for independent developers and determine if this approach is scalable beyond captive builds by hyperscalers. The market will be watching for signals that confirm the commercial viability of this strategic pivot.

  • If this happens: T 1 Energy announces a long-term lease agreement with a major cloud provider (like AWS, Google, Microsoft) or a leading AI company for a significant portion of the 50 MW capacity before 2027. Watch this: The financial terms of the lease and whether it includes options for future expansion on the site. This would provide a powerful market signal that guaranteed clean power outweighs the drawbacks of a secondary market location.
  • If this happens: Competitors announce multiple 100+ MW projects in Norway or Finland throughout 2026 and 2027. Watch this: Any statements from Statnett or other Nordic grid operators regarding the remaining capacity for data center allocation. This could indicate that T 1 Energy’s window of opportunity as a first-mover is closing faster than anticipated.
  • These could be happening now: T 1 Energy may be in advanced negotiations with long-lead equipment suppliers (e.g., transformers, switchgear), using its firm power commitment as leverage to secure production slots. The company is also likely using the Statnett agreement to secure more favorable terms for project financing, arguing that the primary development risk has been eliminated.
T1 Energy's Mo i Rana AI Data Center Project vs. Typical US AI Data Center
Metric T1 Energy (Mo i Rana, Norway) Typical US AI Data Center (2026) Source
Secured Power Capacity (MW) 50 100–750 AI Data Center Power Requirements 2026: The Grid-to-Chip …
Primary Power Source Near-100% Hydropower Grid Mix (Varies by state, often includes significant fossil fuels) T1 Energy secures 50MW grid power for Nordic data center
Facility Size (sq. ft.) 926000 Varies (often 1M+ sq. ft. campuses)
Capacity Online Timeline Q2 2027 – End-2033 Often delayed years past approval due to grid interconnection Why AI Data Center Projects Face Years of Delays After …
Grid Operator Statnett (Norway) Regional Transmission Organizations (e.g., PJM, ERCOT) T1 Energy Secures 50MW Grid Allocation for Nordic Data Center …
iBlank cells indicate the underlying source did not report a value for that column.

The questions your competitors are already asking

This report covers one angle of the data center industry’s power-first site selection strategy. The questions that matter most depend on your work.

This report does not answer these. Enki Brief Pro does.

Your question, your angle, your framework. SWOT, PESTL, scenario modelling. The same niche depth, built around the decision your work actually depends on.

Run your first brief in Enki Brief Pro


Erhan Eren

Erhan Eren is the CEO and Co-Founder of Enki, a commercial intelligence platform for emerging technologies and infrastructure projects, backed by Equinor, Techstars, and NVIDIA. He spent almost a decade in oil and gas, first at Baker Hughes leading market intelligence, strategy, and engineering teams, then at AI startup Maana, where he spearheaded commercial strategy to acquire net new accounts including Shell, SLB, and Saudi Aramco. It was across these roles, watching teams stitch together executive briefings from scattered PDFs and Google searches, that the idea for Enki was born. Erhan holds a BS in Aeronautical Engineering from Istanbul Technical University and an MS in Mechanical and Aerospace Engineering from Illinois Institute of Technology. He has spent over 20 years at the intersection of energy, strategy, and technology, and built Enki to give professionals the clarity they need without the analyst-grade budget or timeline.
