Please login to bookmark Close

Green Hydrogen Cancellations, $7 B DOE Hubs Cut, Air Products’ $500 M Project Exit, and 60+ Projects Halted (2024-2025)

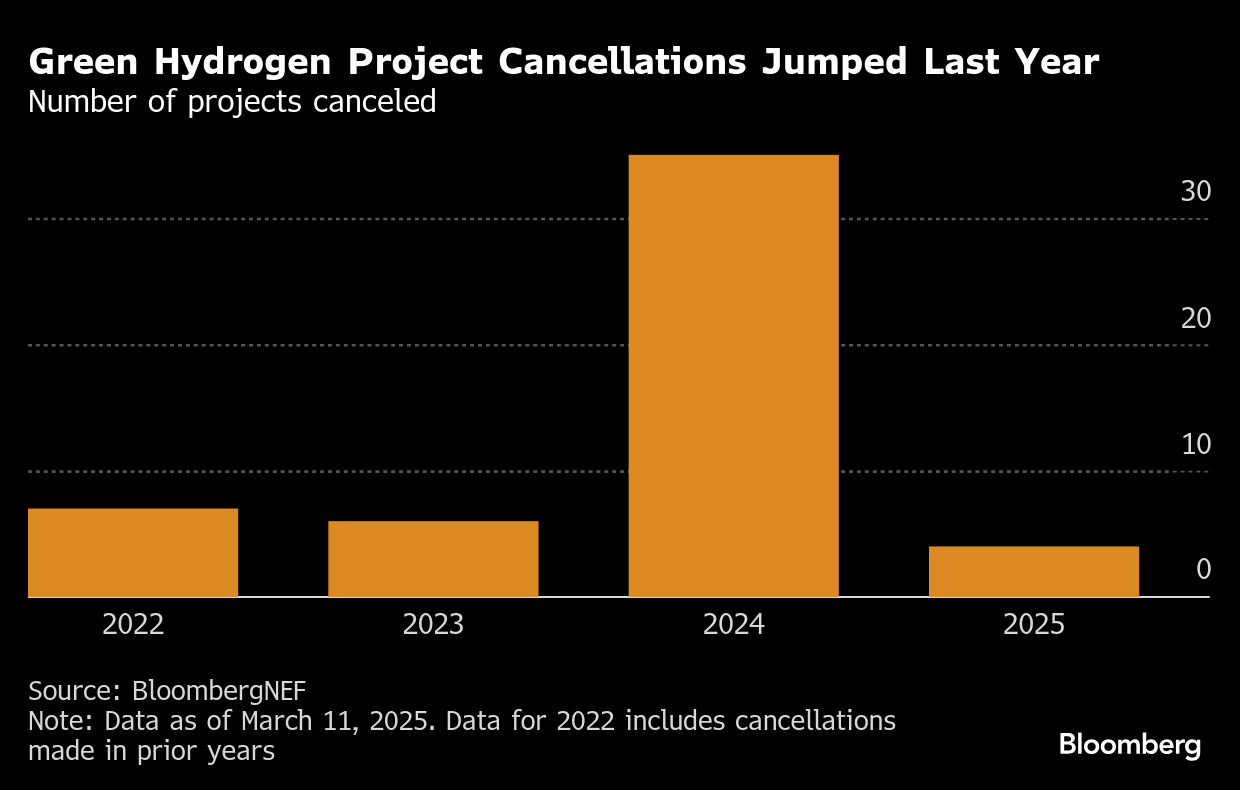

Project Viability Risk, 60+ Green Hydrogen Cancellations Signal Market Correction

The global clean hydrogen sector underwent a material market correction in 2024 and 2025, where widespread project cancellations exposed systemic risks related to economic viability, uncertain offtake, and wavering policy support. This period marked a transition from ambitious announcements to a pragmatic reassessment of the challenges facing large-scale hydrogen deployment, filtering out ventures that lacked a clear path to profitability.

The Shift from Hype to Commercial Reality

Prior to 2024, the industry was characterized by a surge in giga-scale project announcements, driven by decarbonization targets and anticipated government subsidies. However, the period from January 2024 to late 2025 revealed a sharp divergence between announcements and Final Investment Decisions (FIDs). Over 60 major green hydrogen projects were canceled in 2025 alone, representing a potential capacity loss of 4.9 million tonnes per year. This contrasts with the prior period, where such announcements were met with optimistic market valuations.

Primary Drivers of Project Failures

The wave of cancellations was not caused by a single issue but by a convergence of fundamental economic and logistical hurdles that early announcements failed to address. The data shows that high production costs, the absence of firm and bankable offtake agreements, and insufficient infrastructure for storage and transport were primary factors. In 2024, 3.6 GW of electrolyzer capacity was canceled or halted, and this trend accelerated into 2025, highlighting that many projects were commercially unviable without sustained, high-level subsidies which failed to materialize or proved insufficient.

Hydrogen Reality Check 2026: Why Project Cancellations Expose a Deep Viability Gap — Hydrogen Pipeline Shrinks by 10 Mtpa: Projects Face Major Setbacks

Hydrogen Pipeline Shrinks by 10 Mtpa: Projects Face Major Setbacks

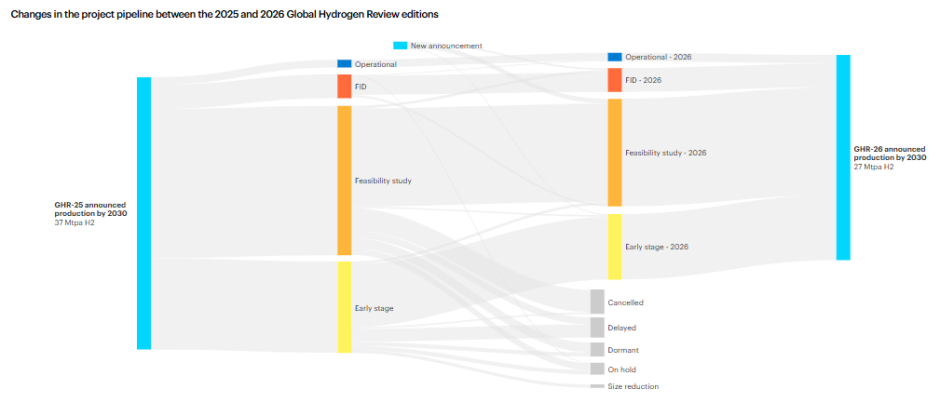

The global hydrogen project pipeline saw a significant 27% reduction in announced production by 2030, dropping from 37 Mtpa H2 (GHR-25) to 27 Mtpa H2 (GHR-26). A substantial portion of projects, particularly those in ‘Feasibility study’ and ‘Early stage’, were either ‘Cancelled’, ‘Delayed’, or ‘On hold” between 2025 and 2026, indicating considerable attrition.

(Source: Hydrogen Reality Check 2026: Why Project Cancellations Expose a Deep Viability Gap)

$20 B+ in Funding Cuts, US DOE and Corporate Strategy Shifts Halt Hydrogen Growth

Major project terminations were directly linked to significant shifts in government funding and corporate strategy, particularly in the United States. The cancellation of federal programs and strategic pivots by industry leaders like Air Products and Plug Power removed critical financial support and signaled a broader cooling of investment in capital-intensive green hydrogen production facilities.

US Government Policy Reversal Impact

The most significant blow came in October 2025 with the confirmed termination of the $7 billion U.S. Department of Energy (DOE) Regional Clean Hydrogen Hubs program. This single action jeopardized the entire national strategy and formed part of a broader cancellation of over $20 billion in clean energy awards. Projects that were heavily reliant on this anticipated federal backing, such as the Pacific Northwest Hydrogen Hub and scale-up plans for Plug Power’s New York facilities, were immediately halted, creating massive uncertainty across the domestic supply chain.

Corporate Reassessments and Financial Strain

Alongside government policy shifts, major corporations initiated their own strategic retreats. In November 2025, Plug Power paused its factory expansion plans and announced it would not utilize a $1.66 billion federal loan. Earlier in the year, in February 2025, Air Products canceled its planned $500 million green hydrogen facility in New York, citing unfavorable economics. These corporate decisions reflect a pragmatic response to persistent financial losses and a recognition that the market for green hydrogen was not developing as quickly as projected. Other major players like BP and Fortescue also canceled or deferred significant hydrogen projects in 2025-2026.

Table: Major Hydrogen Project Cancellations (2024–2025)

Project / Program Time Frame Details and Strategic Purpose Source
Plug Power U.S. Factory Expansion Nov 2025 Paused plans for several new green hydrogen factories and declined a $1.66 billion federal loan guarantee amid financial strain and a strategic pivot. Times Union
U.S. DOE Hydrogen Hubs Program Oct 2025 The entire $7 billion federal program to establish regional hydrogen hubs was terminated, part of a wider $20 billion+ cut in clean energy funding, affecting all five remaining hubs. Fuel Cells Works
Central Queensland Hydrogen (CQ-H 2) Project Jun 2025 The AUD$14 billion project, with a planned 3 GW electrolyzer capacity, was canceled after lead partner and state-owned entity Stanwell withdrew its support. ABC News
Air Products Green Hydrogen Project (New York) Feb 2025 The planned $500 million green hydrogen production facility was canceled due to unfavorable economic viability, a significant setback for New York’s clean energy goals. E&E News
Hy Stor Energy Mississippi Project Oct 2024 The company indefinitely delayed its planned green hydrogen hub in Mississippi, citing an inability to secure offtake agreements as a primary reason. Canary Media
Shell Holland Hydrogen I (Aukra) Sep 2024 Shell shelved its green hydrogen project at the Nyhamna gas processing plant in Norway, citing a lack of demand and an immature market. Reuters
Summary of Major Hydrogen Project Cancellations (2024-2025)
Project/Program⇅ Lead Company/Entity⇅ Region⇅ Capacity/Value⇅ Cancellation Date⇅ Stated Reason⇅ Source⇅
Duqm Green Hydrogen Project Various Oman 1.5 GW / 150,000 tpa Dec 2025 Strategic Reassessment Clean hydrogen project cancellations point to narrower future ↗
Regional Clean Hydrogen Hubs U.S. Department of Energy USA $7 Billion Program Oct 2025 Broader federal funding cuts DOE to Cancel Hydrogen Hub Grants, Leaked Docs Reveal ↗
U.S. Factory Expansion Plug Power USA $1.66 Billion Loan Nov 2025 Shift in priorities, financial strain Plug Power puts factory builds on hold, backing off $1.66B loan ↗
Green Hydrogen Project Air Products New York, USA $500 Million Feb 2025 Economic viability concerns ‘Green’ hydrogen ‘on life support’ as major projects canceled ↗
European Project Pipeline (Aggregate) Various EU 29 GW (stalled/canceled) Dec 2024 Funding barriers, high costs, demand challenges European Hydrogen Projects Stalled or Cancelled ↗
Australian Renewable Energy Hub BP Australia Part of 18 global projects Mar 2025 Broader strategic pivot An Analysis of Project Cancellations and the Path to a Viable Market ↗
Green Hydrogen Projects Repsol Spain Early 2025 Unclear regulations, investment uncertainty Overcoming hurdles and harnessing the potential of … ↗
Green Hydrogen Production LEAG Europe Scaled back by 2/3 Mar 2024 Lack of funding Cancelled and postponed green hydrogen projects ↗
iBlank cells indicate the underlying source did not report a value for that column.

North America vs. Australia, Global Green Hydrogen Hub Cancellations Expose Regional Risks

The contraction in the hydrogen market was global, but the underlying causes of project failures varied by region, exposing different vulnerabilities in national strategies. In North America, cancellations were predominantly driven by the abrupt withdrawal of government policy support, while in Australia, the collapse of mega-projects was more closely tied to fundamental market and economic weaknesses.

Policy Whiplash in the United States

The United States became a case study in policy-induced risk. The termination of the DOE’s Hydrogen Hubs program and other clean energy awards in late 2025 created a chilling effect on investment. This directly impacted projects like the Northwest Hydrogen Hub and manufacturing expansions by companies such as Plug Power in New York. The cancellation of Air Products’ $500 million New York project further underscored the region’s challenges, even before the wider federal cuts took effect, showing that the economics were fragile from the start.

Economic Realities in Australia

In Australia, projects failed not from a lack of political will but from an inability to create a competitive business case for exports. The cancellation of the massive AUD$14 billion Central Queensland Hydrogen (CQ-H 2) project in June 2025 and Fortescue’s decision to drop its Gladstone PEM 50 project highlighted the immense difficulty of producing green hydrogen at a cost that could compete in global markets. These projects, intended as cornerstones of Australia’s green energy export ambitions, were ultimately deemed uncompetitive and too costly to proceed.

Major Hydrogen Project Cancellations and Delays (2024-2025)
Cancellation Date⇅ Company⇅ Project Name⇅ Market Segment⇅ Location⇅ Capacity⇅ Stated Reason for Cancellation⇅ Source⇅
Dec 2025 BP HyGreen Teesside Green Hydrogen Teesside, UK Conflict over land use with a planned data center. BP Pulls Out of Hydrogen Project in Northern England – WSJ ↗
Oct 02, 2025 U.S. Department of Energy Pacific Northwest Hydrogen Hub (PNW H2) Green Hydrogen Washington, USA Hub Program Trump administration yanked federal funding. Trump administration yanks funding for Northwest green … ↗
Oct 02, 2025 U.S. Department of Energy California clean hydrogen hub (ARCHES) Green Hydrogen California, USA Hub Program Trump administration cancelled federal funding. Trump administration yanks funding for Northwest green … ↗
Aug 2025 Repsol / RIC Energy Hydric Project Green Hydrogen Puertollano, Spain 200 MW Deemed economically unfeasible after feasibility studies. Hydrogen Compass – August 2025 – Westwood ↗
Jul 2025 Fortescue PEM50 Gladstone Green Hydrogen Gladstone, Australia 50 MW Costly, uncompetitive, and uncertain market conditions. The Green Hydrogen Reckoning: An Analysis of Project … ↗
Jun 2025 Stanwell Corporation Central Queensland Hydrogen Project (CQ-H2) Green Hydrogen Gladstone, Australia Up to 3 GW Lead partner Stanwell withdrew from the project. Developers dump Gladstone’s Central Queensland … ↗
Feb 24, 2025 Air Products Massena Green Liquid Hydrogen Plant Green Hydrogen New York, USA 35 metric tons/day Strategic decision to exit three US-based projects; incurred up to $3.1B charge. Air Products to Exit Three U.S.-Based Projects ↗
Oct 01, 2024 Hy Stor Energy / Nel Mississippi Clean Hydrogen Hub Electrolyzer Order Electrolyzer Supply Mississippi, USA 1 GW Market headwinds, delays, and financial unfeasibility. What’s next for hydrogen as 8 major companies abandon … ↗
Sep 23, 2024 Shell Aukra Hydrogen Hub Blue Hydrogen Aukra, Norway Lack of immediate demand and insufficient market development. Shell shelves Norway hydrogen project due to lack of … ↗
iBlank cells indicate the underlying source did not report a value for that column.

Electrolyzer Scale-Up Challenges, Giga-Scale Green Hydrogen Projects Prove Premature

The wave of cancellations in 2024-2025 reveals a critical disconnect between the maturity of electrolyzer technology and the ambition of giga-watt scale production hubs. While the core technology for producing green hydrogen is proven, the economic and logistical framework needed to support massive NEOM-style projects does not yet exist, forcing a market-wide recalibration of project size and scope.

The Gap Between Announcements and FID

The IEA’s Global Hydrogen Review 2025 noted that persistent delays and cancellations have significantly reduced the projected low-emission hydrogen output for 2030 to just 37 million tonnes per year. The cancellation of 3.6 GW of electrolyzer capacity in 2024 alone shows that developers are struggling to move beyond feasibility studies. The primary obstacles are securing cost-competitive renewable electricity via PPAs and lining up bankable offtake agreements, without which multi-billion dollar FIDs are impossible.

Forced Pivot to Industrial Clusters

The failure of speculative export-oriented mega-projects is forcing a strategic pivot toward smaller, more viable applications. The market is now shifting focus to projects co-located with existing industrial demand, such as refineries, chemical plants, and steel mills. This model reduces reliance on non-existent transport infrastructure and connects supply directly with offtakers who can absorb the “green premium.” This trend suggests the near-term future of hydrogen is in decarbonizing hard-to-abate industrial clusters, not as a broad commodity for export.

SWOT Analysis, Green Hydrogen’s Path Forward After 2025 Project Cancellations

The market correction of 2024–2025 provided a harsh but necessary stress test for the global hydrogen industry. It exposed critical weaknesses in business models reliant on subsidies and speculative demand, but it also clarified the sector’s core strengths and created opportunities for more resilient strategies to emerge. The path forward requires a focus on projects with solid economic fundamentals.

Table: SWOT Analysis for Green Hydrogen Project Viability

SWOT Category 2021 – 2023 2024 – 2025 What Changed / Resolved / Validated
Strengths High decarbonization potential; strong policy support and hype cycle; numerous large-scale project announcements globally. Proven value for hard-to-abate industrial sectors; technology validated at MW scale; projects with existing offtakers proceed. The value proposition for industrial feedstock (e.g., green steel, ammonia) was validated, while speculative use cases like broad transport fuel were questioned.
Weaknesses Underestimated production costs; dependence on future cost declines in renewables and electrolyzers; lack of offtake agreements. High production costs confirmed (“green premium”); lack of infrastructure; revealed dependency on massive, unstable subsidies. The market validated that high costs and lack of offtakers were deal-breakers, as seen in the Hy Stor Energy and Shell Aukra cancellations.
Opportunities Capture first-mover advantage in a massive future market; secure land and government incentives for mega-projects. Pivot to smaller, co-located industrial projects; focus on niches with clear business cases; potential for M&A as weaker players exit. The failure of mega-hubs like CQ-H 2 creates an opening for more focused, profitable projects that serve existing industrial customers, reducing risk.
Threats Potential for policy changes; competition from blue hydrogen; slow development of transport and storage infrastructure. Policy reversal (e.g., US DOE cuts); sustained high renewable energy costs; investor fatigue and capital flight to other clean technologies. The threat of policy instability was fully realized with the $7 billion U.S. Hydrogen Hub cancellation, confirming it as a primary external risk.
Green Fuel Journal Research & Intelligence Team — Green Hydrogen Faces Major Project Cancellations Amidst Cost Surge

Green Hydrogen Faces Major Project Cancellations Amidst Cost Surge
The green hydrogen industry is experiencing a ‘reality check” between 2024-2026, driven by a 57% increase in electrolyser costs since 2022 and high debt expenses. Approximately 60 major projects were cancelled in 2025, leading to a significant 4.9 Mt/yr reduction in global low-emissions hydrogen production guidance.

High Debt & Cost Overruns Force Industry Consolidation
The surge in electrolyser costs and debt rates, now 3x that of mature renewables, makes speculative hydrogen projects unbankable, triggering significant market consolidation. This ‘reset” reverses prior cost-decline assumptions, highlighting the critical need for robust financial backing and regulatory stability to de-risk future investments.

(Source: Green Fuel Journal Research & Intelligence Team — via Hydrogen Cancellations 2026: A Viability Gap Exposed)

Future Viability, Air Products’ Next Move After Halting 3 Major US Hydrogen Projects

The critical determinant for the hydrogen sector’s recovery post-2025 will be a demonstrated ability to finance and build projects based on firm, long-term offtake agreements rather than speculative government support. The industry must prove it can deliver hydrogen at a price industrial customers are willing to pay, shifting from a supply-push to a demand-pull model. After a major $4 B project cancellation, Topsoe is one of many firms facing this challenge.

  • If this happens: Developers begin consistently announcing FIDs for projects under 500 MW that are backed by 10- to 15-year offtake contracts from buyers in the steel, ammonia, and refining industries.
  • Watch this: The evolution of the “green premium” in these new contracts will be the key metric. If the premium remains too high for unsubsidized adoption, the market will remain stalled. Also, watch for renewed interest in blue hydrogen projects, like those considered by BP, as a more economically viable near-term pathway.
  • These could be happening: A strategic consolidation in the market, where financially stable industrial gas companies like Linde and Air Liquide acquire struggling pure-play hydrogen developers. Furthermore, expect a geographic refocus on regions with stable industrial policy and high-capacity renewable resources, such as the Middle East for export-focused projects like the Egypt hydrogen initiatives.
Green Hydrogen Market Size Forecasts: A Comparative Analysis
Forecast Provider⇅ Market Segment⇅ 2024 Market Size ($B)⇅ 2030 Forecast ($B)⇅ 2031 Forecast ($B)⇅ CAGR (%)⇅ Source⇅
The Insight Partners Green Hydrogen 8.38 57.45 * 71.31 37.80 Green Hydrogen Market Size, Growth & Forecast 2031 ↗
ResearchAndMarkets.com Green Hydrogen 9.09 134.86 211.39 * 56.75 Green Hydrogen Market Report 2025-2030 ↗
iMissing data has been automatically filled using calculation methods (e.g., CAGR projections derived from a source’s own reported values). Calculated values are displayed in blue * — hover any value to see the formula used.
