Fervo Energy Enhanced Geothermal, $421 M in Financing, 500 MW Cape Station Project, and 2 Utility PPAs (2021 to 2026)

500 MW Commercial Scale, Fervo Energy Moves Enhanced Geothermal from Pilot to Bankable Asset

Enhanced Geothermal Systems (EGS) have transitioned from a nascent, experimental technology to a commercially bankable, utility-scale asset class, primarily driven by the successful deployment of Fervo Energy’s Cape Station project. The market has shifted from small, government-backed research initiatives to privately financed, multi-hundred-megawatt power plants secured by long-term corporate and utility power purchase agreements.

  • Between 2021 and 2024, EGS development was characterized by pilot projects focused on technological validation, such as Fervo Energy’s initial demonstration project that first proved the viability of pairing horizontal drilling with geothermal. These early efforts were critical for proving the technology but did not represent commercial-scale power generation.
  • From 2025 to today, the market entered a commercialization phase with the approval and construction of the 500 MW Cape Station. This project’s scale, backed by major offtake agreements with entities like Southern California Edison for 373 MW and Shell Energy for 31 MW, confirms EGS as a source of firm, dispatchable renewable energy.
  • The project’s initial well tests at Cape Station demonstrated outputs exceeding 10 MW per well, a significant increase from the industry average and a key factor in proving commercial viability. This performance, combined with a demonstrated reduction in per-well drilling costs from $9.4 million to $4.8 million, underpins the economic model for large-scale deployment.

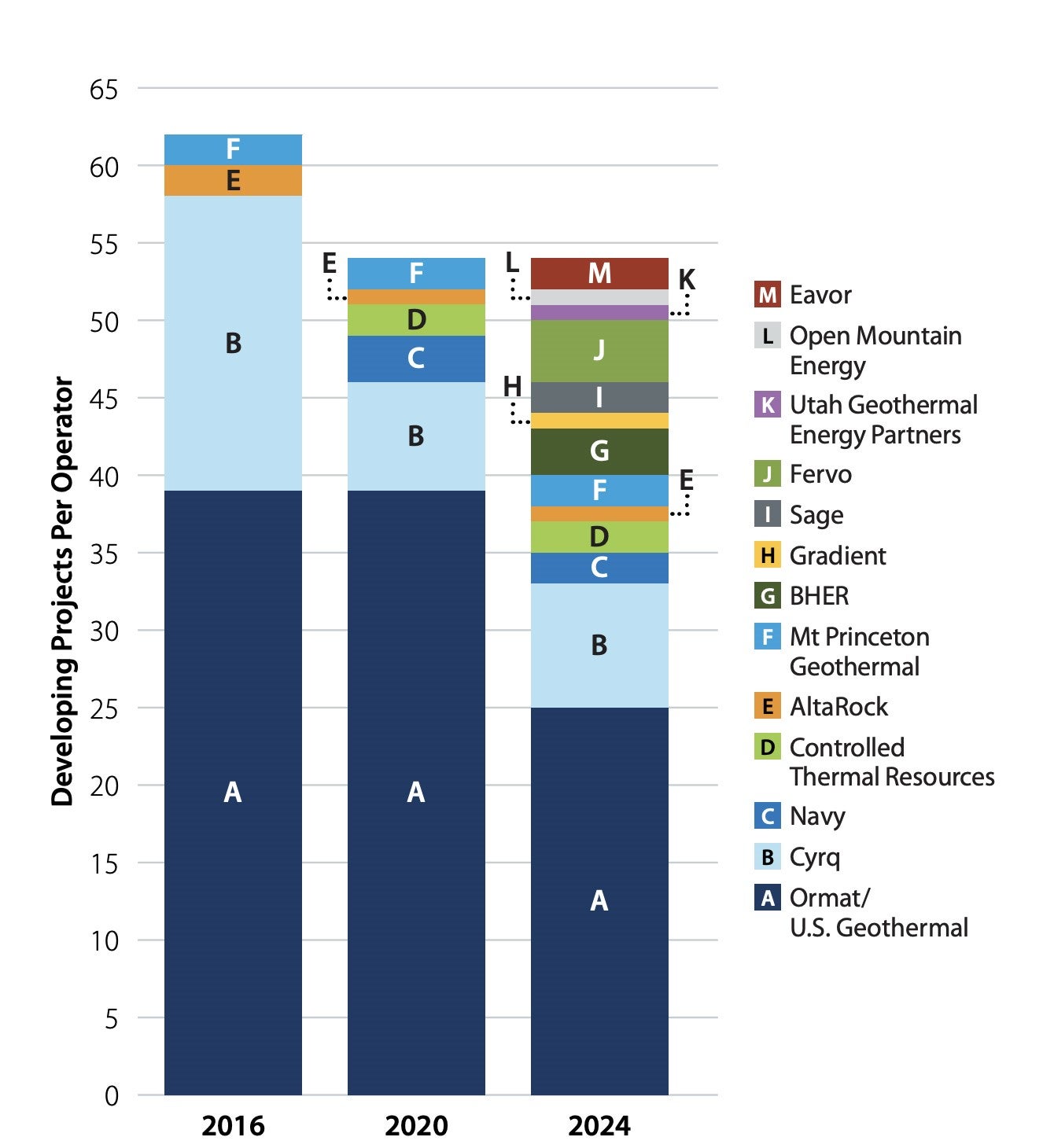

New Entrants Disrupt Geothermal Project Landscape

The chart illustrates the market disruption caused by new players like Fervo, whose 500 MW commercial-scale project marks a significant shift from pilot to a bankable, landscape-altering asset class.

(Source: POWER Magazine)

Fervo Energy $1.89 B IPO and $421 M in Project Financing (2026)

The successful financing of the Cape Station project, culminating in a major IPO, confirms that EGS technology has crossed a critical threshold of bankability, attracting significant institutional capital and non-recourse debt. This financial validation de-risks the technology class and provides a repeatable funding model for future utility-scale projects, moving beyond reliance on venture capital and government grants.

  • In March 2026, Fervo Energy secured $421 million in non-recourse project financing, a landmark event for the next-generation geothermal sector that demonstrated lender confidence in the project’s long-term revenue streams from secured PPAs. This type of financing is standard for mature infrastructure assets, signaling a major shift in market perception.
  • This project-level debt was preceded by substantial growth equity, including a $462 million Series E round in late 2025, which funded the corporate expansion and technology development needed to advance projects like Cape Station.
  • The market’s confidence was further solidified in May 2026 when Fervo Energy launched a $1.89 billion IPO on Nasdaq, achieving a valuation of $7.66 billion. This event provides the company with a substantial balance sheet to execute its multi-gigawatt development pipeline.

Table: Fervo Energy Key Financial Milestones for Cape Station

Metric Time Frame Details and Strategic Purpose Source
IPO Valuation May 2026 Achieved a $7.66 billion valuation upon listing on Nasdaq, providing a massive capital base for future project development. Business Energy Awards
Non-Recourse Project Financing Mar 2026 Secured $421 million in project-specific debt to fund the construction and expansion of Cape Station. Fervo Energy
Series E Funding Dec 2025 Raised $462 million from investors including Google to accelerate the development of its project pipeline. Renewable Energy Magazine
New Project Financing Jun 2025 Raised an additional $206 million specifically to support the flagship Cape Station Project. Houston Business Journal

Supply Chain Alliances, Fervo Energy Secures Baker Hughes and Turboden

Fervo Energy has mitigated execution risk and accelerated its development timeline by forming strategic alliances with established industrial technology providers for critical power plant equipment. Instead of vertically integrating manufacturing, this partnership model leverages mature, proven supply chains for turbines and electrical systems, allowing Fervo Energy to focus on its core competency in subsurface drilling and reservoir engineering.

  • In October 2025, Fervo Energy announced that Turboden, a subsidiary of Mitsubishi Heavy Industries, would supply 180 MW of its Gen 2 Organic Rankine Cycle (ORC) power plants for Cape Station, bringing Turboden’s total commitment at the site to 300 MW.
  • For Phase II of the project, Fervo Energy contracted Baker Hughes in September 2025 to supply five 50 MW ORC turbine units, totaling 250 MW of power generation equipment for the site’s expansion to 500 MW.
  • In January 2026, ABB was selected to provide essential electrical equipment, including motor control solutions, integrating another tier-one industrial supplier into the project’s ecosystem to ensure power plant reliability and performance.

Tech Giants Partner on Large-Scale Geothermal Projects

This chart visually supports the section’s theme by highlighting the trend of major technology and energy companies forming partnerships to scale geothermal energy, directly aligning with Fervo’s alliances with Baker Hughes and Turboden.

(Source: Information Technology and Innovation Foundation (ITIF))

Table: Fervo Energy Key Technology and Equipment Partnerships

Partner / Project Time Frame Details and Strategic Purpose Source
ABB Jan 2026 Selected to provide motor control solutions and other electrical equipment for the Cape Station power plant. ABB
Turboden (Mitsubishi) Oct 2025 Contracted to deliver three Gen 2 ORC units totaling 180 MW, expanding its role as a key turbine supplier. Turboden
Baker Hughes Sep 2025 Contracted to supply five 50 MW ORC turbine units for the 400 MW Phase II expansion of Cape Station. Renewable Energy World

Utah, Fervo Energy Establishes a Major US Geothermal Hub at Cape Station

Beaver County, Utah has become the undisputed center of next-generation geothermal development in the United States, anchored by the co-location of the DOE’s FORGE research site and Fervo Energy’s commercial-scale Cape Station project. This geographic concentration creates a powerful feedback loop, where federally funded R&D directly informs commercial drilling techniques, while commercial-scale operational data validates the region’s vast geothermal potential.

  • Between 2021 and 2024, geothermal activity in Utah was primarily centered on the FORGE initiative, an academic and research-focused site dedicated to testing EGS technologies and drilling methods in a controlled environment.
  • Starting in October 2024, the dynamic shifted decisively toward commercialization when the U.S. Bureau of Land Management (BLM) approved Fervo Energy’s proposal for the multi-phase Cape Station plant. Construction officially broke ground that same month.
  • The site in Beaver County is strategically significant due to its vast resource potential, with permits secured for up to 2 GW of total capacity. This indicates that Cape Station is not a one-off project but the first phase of a multi-decade development that could establish Utah as a primary exporter of firm, clean power to the Western U.S.

Map Shows Fervo’s Key Geothermal Projects

The map provides direct geographical context for this section, visually locating the Cape Station project in Utah and positioning it among Fervo’s other key operational areas.

(Source: Insider | Orennia | Substack)

Technology Maturity at Commercial Scale Confirmed for Enhanced Geothermal

Enhanced Geothermal Systems have achieved commercial maturity, a verdict supported by demonstrated cost reductions, replicable well productivity, and the ability to secure long-term, fixed-price contracts from sophisticated energy buyers. The technology has progressed beyond the scientific validation stage and is now in an engineering and industrialization phase focused on optimizing deployment and scaling the supply chain.

  • From 2021 to 2024, the primary technological challenge was proving that horizontal drilling and stimulation techniques from the shale industry could create sufficient fluid flow and heat extraction for power generation. Fervo’s pilot project with Google successfully validated this core concept.
  • In the period from 2025 to today, the focus has shifted to commercial execution and cost optimization. At Cape Station, Fervo Energy achieved flow rates of 93-120 Liters per second, well above the commercial viability threshold, and reduced drilling time by 70% compared to its pilot.
  • The technology’s commercial readiness is ultimately confirmed by its bankability. Securing $421 million in non-recourse project financing and executing a 373 MW, 15-year PPA with Southern California Edison are commercial validations that the technology’s performance and cost structure are reliable enough for utility-scale infrastructure investment.

Geothermal Capacity Reached 4,000 MW by 2020

This chart provides historical context on the overall geothermal market size, serving as a baseline to underscore the significance of Fervo’s commercially mature technology in driving future capacity growth beyond previous levels.

(Source: POWER Magazine)

SWOT Analysis, Fervo Energy at Cape Station

The strategic position of Enhanced Geothermal Systems, as demonstrated by the Cape Station project, is defined by its first-mover advantage in a market demanding firm, clean power, but it faces external threats related to grid infrastructure and inherent operational risks. The technology’s strengths are rooted in proven cost reductions and productivity gains, while its primary opportunity lies in servicing the immense power demand from the AI and data center industry.

Table: SWOT Analysis for Fervo Energy’s Cape Station Project

SWOT Category 2021 – 2024 2025 – 2026 What Changed / Resolved / Validated
Strengths Demonstrated technical feasibility of horizontal drilling for geothermal in a pilot project. Achieved 70% reduction in drilling time and cut per-well costs from $9.4 M to $4.8 M. Secured 500 MW in PPAs. The technology’s economic viability and commercial scalability were validated, moving from a concept to a bankable asset.
Weaknesses High initial drilling costs and uncertainty around well productivity and long-term performance. A well blowout occurred during development in May 2026, highlighting ongoing operational risks even with advanced techniques. While costs are down, subsurface operations retain inherent risks that require sophisticated management and mitigation strategies.
Opportunities Growing demand for 24/7 carbon-free energy to complement intermittent renewables like wind and solar. Explosive electricity demand from AI and data centers. Fervo is explicitly targeting a “Geothermal Data Center Corridor.” The market opportunity expanded from general grid decarbonization to servicing a specific, high-growth, high-value customer segment.
Threats Competition from other firm power technologies like advanced nuclear or long-duration storage. Regulatory uncertainty. Grid interconnection queues and lack of transmission capacity in key regions emerge as the primary bottleneck to growth. The main barrier to deployment shifted from technology risk to systemic infrastructure constraints outside of the developer’s direct control.

Scenario Modeling: Fervo Energy’s Next Test Is Execution, Not Technology

The critical factor for Fervo Energy and the broader EGS sector in the next 12-24 months is the ability to execute on a multi-project pipeline, navigating supply chain constraints and grid interconnection bottlenecks. With the core technology de-risked and project financing models established, the primary uncertainty shifts from “if it works” to “how fast it can scale.” The success of Cape Station’s initial 100 MW grid connection in 2026 will be a pivotal signal for the market.

  • If Fervo Energy successfully brings the first phase of Cape Station online on schedule in 2026, watch for an acceleration in the announcement of new, large-scale projects and PPAs, particularly with data center operators. This would confirm the “repeatable, bolt-on development model” is working.
  • Conversely, if there are significant delays in the grid interconnection process for Cape Station or follow-on projects, it could signal that transmission constraints are a more severe bottleneck than anticipated. This could slow the pace of new project announcements, even with strong offtaker demand.
  • As a result of these dynamics, the market could see a bifurcation. Developers with projects in regions with available transmission capacity or co-located with large industrial loads (like data centers) may accelerate, while projects in constrained areas stall, leading to geographic fragmentation of EGS growth.

The questions your competitors are already asking

This report covers one angle of enhanced geothermal’s path to commercial bankability. The questions that matter most depend on your work.

This report does not answer these. Enki Brief Pro does.

Your question, your angle, your framework. SWOT, PESTL, scenario modelling. The same niche depth, built around the decision your work actually depends on.

Run your first brief in Enki Brief Pro


Erhan Eren

Erhan Eren is the CEO and Co-Founder of Enki, a commercial intelligence platform for emerging technologies and infrastructure projects, backed by Equinor, Techstars, and NVIDIA. He spent almost a decade in oil and gas, first at Baker Hughes leading market intelligence, strategy, and engineering teams, then at AI startup Maana, where he spearheaded commercial strategy to acquire net new accounts including Shell, SLB, and Saudi Aramco. It was across these roles, watching teams stitch together executive briefings from scattered PDFs and Google searches, that the idea for Enki was born. Erhan holds a BS in Aeronautical Engineering from Istanbul Technical University and an MS in Mechanical and Aerospace Engineering from Illinois Institute of Technology. He has spent over 20 years at the intersection of energy, strategy, and technology, and built Enki to give professionals the clarity they need without the analyst-grade budget or timeline.

Privacy Preference Center
