Data Center Grid Lock, Google $20 B Intersect Power Deal, 7 GW US Crisis, and $1.7 T Capex Projections (2021 to 2026)

Grid Access Delays, US Faces 7 GW AI Data Center Capacity Crisis and Project Cancellations

The primary constraint on the multi-trillion-dollar artificial intelligence infrastructure buildout has shifted from semiconductor availability to the physical limitations of the global power grid. The inability of electrical infrastructure to accommodate the speed and scale of new demand is causing systemic project delays and cancellations, threatening the growth trajectory of the entire sector. This power bottleneck is forcing a strategic realignment where securing reliable, timely power is now the most critical factor for success.

Hyperscaler Project Delays and Cancellations

The core issue is a fundamental mismatch between the rapid deployment of AI data centers and the multi-year timelines required for grid upgrades and interconnection approvals. Before 2024, data center siting was primarily driven by fiber connectivity and land costs. Today, power availability is the determining factor. This has led to a significant backlog of projects unable to secure power.

  • In the U.S., nearly half of the data centers planned for 2026 have been canceled or delayed, resulting in a 7 GW capacity crisis directly attributable to power grid bottlenecks and long interconnection queues.
  • Some analysts project that 30-50% of planned 2026 AI data center capacity will be postponed until at least 2028 due to these electrical infrastructure constraints, representing a major impediment to near-term AI computational capacity growth.
  • The problem is acute in established data center hubs. In Northern Virginia, the world’s largest data center market, utility Dominion Energy had to pause new data center connections in 2022 due to transmission constraints, a situation that highlighted the growing strain.

The Shift to “Bring Your Own Power” (BYOP)

In response to grid-related delays, a defining infrastructure trend for 2025-2026 is the adoption of “bring your own power” (BYOP) strategies. Hyperscalers are increasingly bypassing utilities by investing directly in their own dedicated energy generation. This strategic pivot, exemplified by ventures like the Liberty Energy Power Bridge joint venture, is driven by the urgent need for “time-to-power” rather than pure cost savings, as the opportunity cost of delayed AI deployment outweighs the premium of building independent power sources.

  • The move toward on-site generation is a direct reaction to the realization that waiting for grid upgrades is no longer a viable business strategy for companies competing in the AI sector.
  • This trend includes co-locating data centers with renewable energy projects, developing microgrids, and exploring dispatchable power sources like natural gas and even small modular reactors (SMRs) to guarantee uninterrupted supply.
Major Corporate Investments and Offtake Agreements in AI Data Center Infrastructure
Date Company / Investor Market Segment Project / Agreement Investment / Value Key Details Source
Feb 1, 2026 Big-5 Hyperscalers AI Infrastructure 2026 CapEx Cycle ~$775B – $800B Projected spending on AI infrastructure by the top 5 hyperscalers in 2026, confirmed in Q1 2026 earnings. AI Capex Cycle 2026: $775–800B Hyperscaler Buildout
Dec 10, 2024 Google, Intersect Power, TPG Clean Energy for Data Centers Strategic Partnership $20B (Target) Partnership to co-locate gigawatts of new data center capacity with renewable power generation across the US. Intersect Forms Strategic Partnership With Google and TPG…
May 21, 2026 Microsoft, Google, Amazon Nuclear Energy Nuclear Offtake Agreements Hyperscalers are actively pursuing offtake agreements for nuclear energy to secure reliable, carbon-free power. Data Center Investment in 2026: AI Demand, Power …
May 26, 2026 Hyperscalers Project Finance Financeable Offtake Agreements Project-dependent Lenders are focused on financing projects backed by long-term leases and offtake agreements with creditworthy hyperscalers. Data Center Project Finance: How to Structure a …
Apr 27, 2026 Hyperscale Tenants Data Center Leasing Master Lease Agreements Negotiation of long-term (10–20 years) Master Lease Agreements or capacity reservations to ensure revenue for developers. Data Center Project Finance | datacenterlandsites.com
iBlank cells indicate the underlying source did not report a value for that column.

$775 B in 2026 Capex, Hyperscalers Fund Massive Data Center and Energy Infrastructure

An unprecedented capital expenditure cycle is underway, driven by the competitive necessity for hyperscalers to build out their AI capabilities. This spending is increasingly directed not just at servers and GPUs but at the underlying power and cooling infrastructure required to run them. The sheer scale of this investment validates the market’s long-term growth thesis, even as it exposes the critical energy constraints.

Top-5 Hyperscaler Capex Projections

Leading hyperscalers like Amazon, Microsoft, Google, Meta, and Oracle are at the forefront of this spending. Their capital allocation plans signal a non-discretionary investment cycle necessary to remain competitive in AI services. This has created a massive tailwind for the entire data center supply chain.

  • Analysts from Dell’Oro Group and others project that the top five hyperscalers alone will spend between $775 billion and $800 billion on data center infrastructure in 2026.
  • The total worldwide data center capex is forecast to grow from approximately $434 billion in 2024 to over $1 trillion by 2029, with some estimates projecting a cumulative $1.7 trillion spend by 2030.
  • These figures represent a significant upward revision from forecasts made before 2024, reflecting the explosive, power-intensive nature of generative AI workloads and the infrastructure required to support companies like Open AI.

Investment in Power-Related Infrastructure

A growing portion of this capital is being allocated to solve the energy problem directly. Power and cooling infrastructure now account for 30-40% of the total cost of a new AI data center, up from a much smaller fraction in traditional facilities. This includes investments in high-density power distribution, liquid cooling systems, and direct financing of new energy generation projects through vehicles like convertible bonds, as seen with firms such as Akamai.

Table: Data Center Capital Expenditure Forecasts

Analyst / Firm Time Frame Details and Strategic Purpose Source
Dell’Oro Group 2030 Forecasts total data center capex to reach $1.7 trillion by 2030, driven by AI workloads and the required infrastructure expansion. Dell’Oro Group
AL Capital Advisory 2026 Projects top five hyperscaler capex to reach $775–$800 billion in 2026 alone as they build out AI compute capacity. AL Capital Advisory
Moody’s 2027 Forecasts the top six U.S. hyperscalers will spend $600 billion on capex in 2027, up from $500 billion in 2026. Data Center Knowledge
Microsoft 2025 Microsoft alone planned $80 billion in data center buildouts for 2025, signaling the massive scale of individual company commitments to AI infrastructure. Avid Think
Data Center & AI Infrastructure Market Size Forecasts
Forecast Provider Market Segment 2024 ($B) 2026 ($B) 2029 ($B) 2030 ($B) CAGR (%) Source
Dell'Oro Group Worldwide Data Center CapEx 434 629.76 * 1100 1325.06 * 20.46 * AI spending review: data centre splurge called into question
Groundwork Collaborative (citing Dell'Oro) Worldwide Data Center CapEx 1700 Gridlocked: How Public Power Can Build the Grid of …
AL Capital Advisory Big-5 Hyperscaler AI Infrastructure Spending 787.50 * AI Capex Cycle 2026: $775–800B Hyperscaler Buildout
McKinsey & Company Total Data Center Investment Need 5200 The cost of compute: A $7 trillion race to scale data centers
Mordor Intelligence AI Infrastructure Market 76.65 * 101.17 153.43 * 176.27 * 14.89 AI Infrastructure Market Size, Trends & Growth Drivers 2031
Mordor Intelligence Hyperscale Datacenter Market 134.20 * 205.48 389.31 * 481.74 * 23.74 Hyperscale Datacenter Market Size, Research Report 2025
iMissing data has been automatically filled using calculation methods (e.g., CAGR projections derived from a source’s own reported values). Calculated values are displayed in blue * — hover any value to see the formula used. Blank cells indicate the underlying source did not report a value for that column, and there was not enough of that source’s own data to calculate one (a growth rate needs at least two reported years).
FocusEconomics — Hyperscaler Capex to Hit $1 Trillion by 2027, Driven by AI Demand

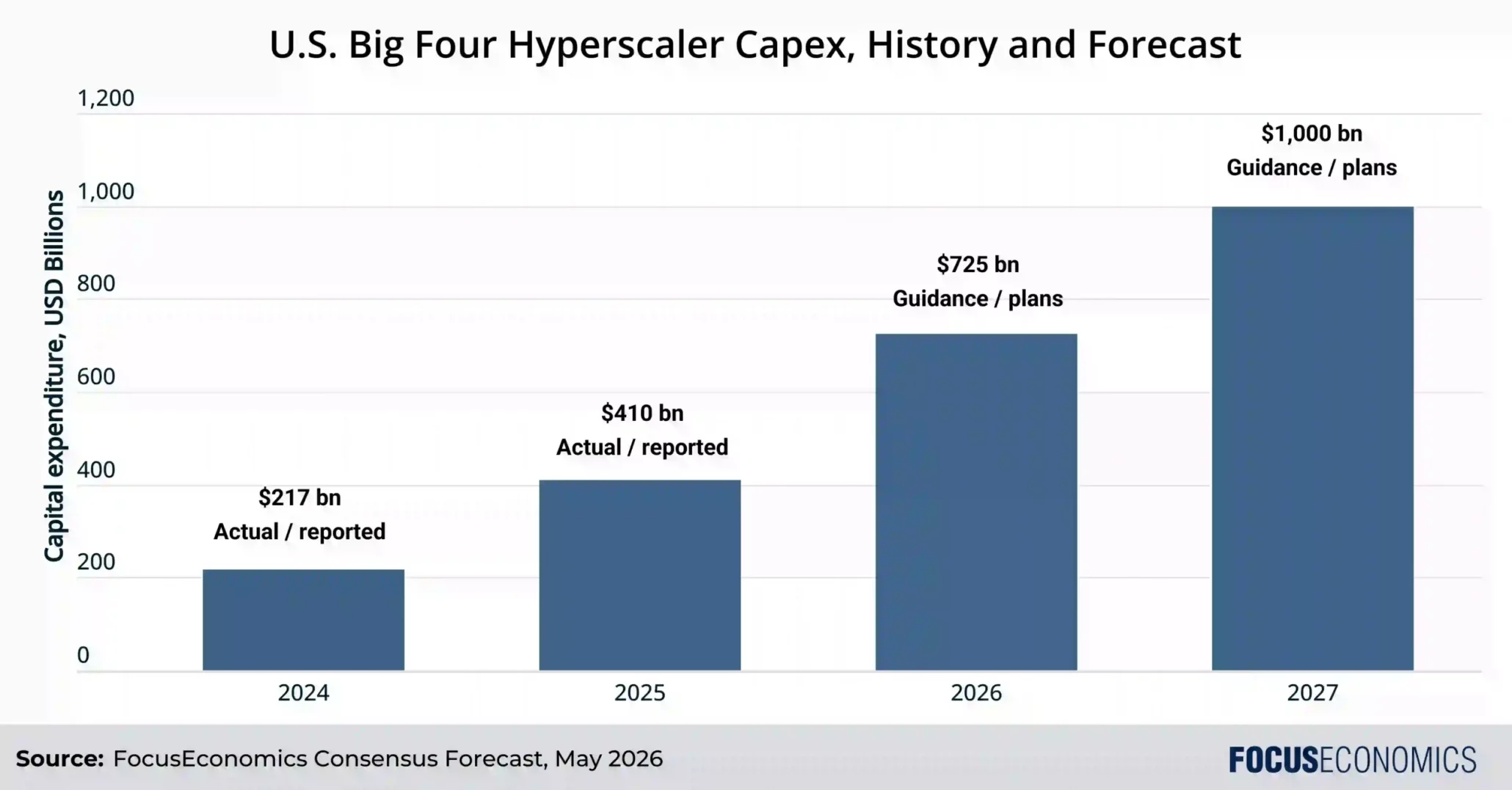

Hyperscaler Capex to Hit $1 Trillion by 2027, Driven by AI Demand
U.S. Big Four Hyperscaler Capex is projected to reach $1 trillion by 2027, quadrupling 2024 investments. This unprecedented surge, driven by escalating AI and data center demands, indicates an accelerating infrastructure arms race among top players.

(Source: FocusEconomics — via Hyperscaler AI & Data Center Energy 2026, $726B Dell'Oro – EnkiAI)

Google $20 B Intersect Power Deal Signals Co-Location Strategy for AI Data Centers (2024 to 2026)

Strategic partnerships between hyperscalers and energy developers have become the primary mechanism to bypass grid logjams. These alliances are moving beyond traditional Power Purchase Agreements (PPAs) toward deeper integration, including the co-location of data centers with power generation facilities. This ensures a dedicated, reliable power source and shortens the critical “time-to-power” for new facilities.

Google and Intersect Power’s Co-Location Model

The late 2024 partnership between Google, Intersect Power, and TPG represents a landmark shift in this direction. The collaboration is a clear signal that hyperscalers are now willing to co-invest in energy infrastructure to secure the power needed for their AI ambitions. This type of deal structure is becoming a template for the industry.

  • The partners launched a $20 billion initiative to co-locate new data centers with clean energy generation projects, directly linking power supply with power demand.
  • This model differs from earlier strategies that relied on purchasing renewable energy credits to offset consumption from grid-connected data centers. The new approach physically integrates the data center with its power source.
  • By financing both the data center and the generation asset together, hyperscalers can de-risk projects for energy developers and accelerate the deployment of both, a strategy also seen in offtake agreements with operators like Hut 8.

Long-Term Power Purchase Agreements (PPAs)

Alongside co-location, hyperscalers are aggressively securing long-term (10-20 year) PPAs and offtake agreements to guarantee future supply and hedge against price volatility. These agreements are crucial for underpinning the financing of new large-scale energy projects, including wind, solar, and potentially nuclear, as seen in partnerships between data centers and large utilities like Next Era Energy.

Table: Key Energy Partnerships for AI Data Centers

Partner / Project Time Frame Details and Strategic Purpose Source
Google, Intersect Power, TPG Dec 2024 Announced a $20 billion strategic partnership to co-locate new data centers with clean energy generation, directly integrating power supply with AI-driven demand. ESG Today
Hyperscalers & Nuclear Developers 2025 – 2026 A broader trend emerged of hyperscalers exploring partnerships with nuclear energy companies, including SMR developers, to secure firm, 24/7 carbon-free power for future data centers. Ropes & Gray
Data Center Unit Economics and Cost Breakdown
Metric Value Details Source
Upfront CapEx (per MW) $10M / MW Typical capital expenditure for data center construction. Economic costs of data-centers?
Upfront CapEx (100 MW Hyperscale) $3.4B – $5.5B Total cost for a 100 MW hyperscale facility, including all infrastructure. A Look at the Cost Structure Igniting the AI Boom!
Upfront CapEx (1 GW AI Data Center) 38 Estimated total upfront capital expenditure for a one-gigawatt AI-specific data center. Total cost of ownership of a one-gigawatt AI data center
Annual OpEx (per MW) $0.8M – $2.0M / MW / year Facility operating expenses at typical Tier III-IV operations. Data centre operating cost structures: traditional cloud versus AI
OpEx Cost Structure c. 40% Maintenance, c. 15-25% Electricity Electricity is a significant but not always dominant portion of operating costs. Economic costs of data-centers?
GPU Performance/Power (NVIDIA GB200) 30x inference speed vs H100 The GB200 Superchip delivers a 30x increase in inference performance at 1,200W, showcasing a significant improvement in performance per watt. Complete Guide to NVIDIA B200 vs GB200 Deployment – Introl

US vs. Global, North America Dominates AI Data Center Growth Amid Power Constraints

North America, and the United States in particular, remains the undisputed epicenter of the AI data center buildout, but its leadership position is being actively challenged by its own infrastructure limitations. While the region attracts the majority of investment, severe power constraints are creating opportunities for other global markets with more available grid capacity or a more streamlined regulatory environment for energy projects.

North American Bottlenecks

The U.S. is home to the most significant planned data center expansion, with total power demand projected to climb from 61.8 GW in 2025 to as high as 134.4 GW by 2030. However, this growth is running directly into the reality of an aging grid that was not designed for such concentrated load growth. The result is a geographic fragmentation of development, with companies seeking out secondary and tertiary markets where power is more readily available.

  • Key markets like Northern Virginia and Silicon Valley are saturated, with multi-year waits for power. This has pushed development towards states like Ohio, Texas, and Arizona, which offer more grid capacity and supportive policies.
  • The 7 GW capacity crisis identified in 2026 is a uniquely American problem at this scale, stemming from a combination of massive demand and a balkanized regulatory and utility landscape that slows infrastructure development.

Emerging Global Locations

While the U.S. grapples with its grid, other regions are positioning themselves to capture a share of the AI infrastructure market. Countries with strong renewable energy resources, supportive governments, and available grid capacity are becoming more attractive. This dynamic is visible in markets like India, where entities such as the Adani Group and Reliance are making substantial investments in data center capacity powered by renewable energy.

U.S. Data Center Power Demand Forecast (GW)
Forecast Provider Market Segment 2025 (GW) 2026 (GW) 2027 (GW) 2028 (GW) 2030 (GW) Source
S&P Global Total U.S. Data Centers 61.80 72.19 * 84.32 * 98.50 * 134.40 The Data Center Power Chain: From Grid to Rack
Goldman Sachs Total U.S. Data Centers 31 45.23 * 66 96.30 * 205.03 * US Data Center Power Demand Projected to Double by 2027
Morgan Stanley Research Total U.S. Data Centers 74 Energy Markets Race to Solve the AI Power Bottleneck
Tech Insider (IEA Data) Total U.S. Data Centers 150 The AI Data Center Power Crisis – Tech Insider
Various (via Reddit) Total U.S. Data Centers 65.95 * 76 87.58 * 100.92 * 134 Datacenters projected to consume 134 GW (~27% of US …
iMissing data has been automatically filled using calculation methods (e.g., CAGR projections derived from a source’s own reported values). Calculated values are displayed in blue * — hover any value to see the formula used. Blank cells indicate the underlying source did not report a value for that column, and there was not enough of that source’s own data to calculate one (a growth rate needs at least two reported years).

Liquid Cooling at Commercial Scale, Direct-to-Chip Solutions Mitigate AI Power Density

The extreme power density of AI hardware has forced the rapid maturation and commercial-scale adoption of technologies that were considered niche prior to 2024. Direct-to-chip liquid cooling has transitioned from a specialized solution to a standard requirement for new AI data centers, driven by the thermal challenge of dissipating heat from server racks that now exceed 100 k W.

The Rise of Direct-to-Chip Cooling

Traditional air cooling is insufficient for the thermal loads generated by modern AI accelerators. The shift to liquid cooling is not an incremental improvement but a necessary architectural change. This technology’s revenue doubled in a single year, highlighting its critical role in enabling the AI buildout. The strategy is central to hardware providers like Dell, which are designing systems around these new thermal management requirements.

  • Modern AI server racks are projected to exceed 600 k W in the near term, with 1 MW rack configurations on the horizon, making advanced liquid cooling solutions non-negotiable for future deployments.
  • The adoption of liquid cooling is a key enabler of deploying high-density GPU clusters, which are the engines of large-scale AI training and inference models. Without it, the physical footprint of AI data centers would be unmanageably large.

The Nuclear and SMR Option

To address the macro-level energy shortage, hyperscalers and data center operators like Equinix are actively exploring nuclear power, particularly Small Modular Reactors (SMRs), as a long-term source of reliable, carbon-free baseload power. While this was a theoretical discussion before 2024, by 2025-2026 it has become a serious strategic consideration, with active talks between tech companies and nuclear developers to power future data center campuses.

Key Infrastructure Bottlenecks for AI Data Center Expansion
Constraint Area Specific Challenge Quantitative Impact Source
Power Grid Grid interconnection queues and substation approval delays Causes multi-year delays; the most acutely binding constraint on growth. The Electricity Supply Bottleneck on U.S. AI Dominance
Project Timelines Combined effect of grid, construction, and supply chain bottlenecks 30-50% of planned 2026 AI data center capacity is projected to slip to 2028. How AI Data Centers Are Reshaping Electronic …
Power Availability Lack of sufficient generation and transmission capacity Projected shortfall of ~49 GW in the U.S. by 2028. Energy Markets Race to Solve the AI Power Bottleneck
Supply Chain Shortages in power equipment, memory, and other hardware components Recurrent supply chain issues are a potential challenge to meeting buildout targets. AI Hardware Demand Outpaces Global Supply Chains

SWOT Analysis, Hyperscaler AI Data Center Energy Buildout

The AI data center market is characterized by a powerful combination of immense demand-side pull and significant capital availability, creating massive opportunities for growth. However, this growth is fundamentally constrained by physical infrastructure limitations, primarily power grid availability, and growing regulatory and community opposition, which pose significant threats to project timelines and costs.

Table: SWOT Analysis for Hyperscaler AI Data Center Energy Market

SWOT Category 2021 – 2023 2024 – 2025 What Changed / Resolved / Validated
Strengths Strong demand for traditional cloud services. Established hyperscaler dominance and balance sheets. Explosive, non-discretionary demand for AI workloads. AI now accounts for over 80% of new data center demand. The primary driver shifted from general cloud growth to power-intensive AI, validating the thesis for a historic capex cycle.
Weaknesses Growing power consumption was a concern, but manageable within existing grid expansion plans. Power availability is now the primary bottleneck. Grid interconnection queues stall projects for years. Inability to cool 100+ k W racks with air. The weakness shifted from an operational cost (energy bills) to a critical path constraint (lack of power access), halting growth.
Opportunities Expansion into new geographic markets. PPA agreements for renewable energy to meet ESG goals. BYOP models, co-location with generation (Google’s $20 B deal). New markets in liquid cooling, power electronics, and grid modernization. Exploring nuclear power. The energy constraint itself created new, multi-billion dollar markets for companies that can solve the power and cooling challenges.
Threats Supply chain disruptions for servers and components. Increasing energy costs. Widespread project cancellations due to power shortages (7 GW US crisis). Local community opposition and permitting delays stalling projects indefinitely. Threats became more severe and immediate, moving from supply chain delays to fundamental barriers to construction and operation.
Global Data Center & Hyperscaler CAPEX Forecasts
Forecast Provider Market Segment 2024 ($B) 2026 ($B) 2027 ($B) 2029 ($B) 2030 ($B) CAGR (%) Source
Dell'Oro Group Global Data Center 455 1000 1210 * 1200 1700 21 AI Boom Drives Data Center Capex to $1.7 Trillion by 2030 …
AL Capital Advisory Big-5 Hyperscaler AI Infrastructure 787.50 * AI Capex Cycle 2026: $775–800B Hyperscaler Buildout
Moody's Top 6 U.S. Hyperscalers 347.22 * 500 600 864 * 1036.80 * 20.00%* Moody’s Forecasts $3 Trillion Data Center Investment by …
iMissing data has been automatically filled using calculation methods (e.g., CAGR projections derived from a source’s own reported values). Calculated values are displayed in blue * — hover any value to see the formula used. Blank cells indicate the underlying source did not report a value for that column, and there was not enough of that source’s own data to calculate one (a growth rate needs at least two reported years).

BYOP Becomes Standard, Hyperscalers Bypass Grids with On-Site Generation in 2026

If grid interconnection delays and capacity shortages persist as the primary obstacle through 2026, the market will see a decisive and accelerated pivot to “bring your own power” models. Expect hyperscalers to move beyond partnerships and become direct developers and financiers of on-site power generation, including natural gas peaker plants for reliability, renewables for sustainability, and SMRs for long-term baseload power.

Signals for BYOP Acceleration

The most critical signal to watch is the volume of capital hyperscalers allocate to energy infrastructure versus data center hardware. Recent trends from 2025 to today confirm this shift is already underway, as companies prioritize securing GWs of power to support their AI ambitions.

  • The strategic focus is shifting from raw FLOPS (Floating-Point Operations Per Second) to a more efficient metric: “tokens-per-watt, ” which underscores the increasing importance of energy efficiency in AI hardware design, a key concern for chipmakers like TSMC.
  • Watch for an increase in direct hiring of energy infrastructure experts and project finance professionals by companies like Amazon, Microsoft, and Google, indicating a move to internalize energy development capabilities.
  • Monitor announcements for new data center campuses that explicitly include plans for on-site, multi-gigawatt power generation facilities as part of the initial design, rather than as a later addition.

Impact on Utility Business Models

This trend poses a direct challenge to traditional utility business models, which are structured around centralized generation and slow, planned load growth. A future where the largest electricity customers build their own power could lead to grid fragmentation and stranded assets. This dynamic will force utilities to innovate, offering faster interconnection services, flexible tariffs, and new partnership models to retain their largest industrial clients.

Key Market and Infrastructure Risks to AI Data Center Buildout
Risk Category Specific Challenge Quantitative Impact / Metric Source
Power Availability Grid Connection Delays & Capacity Shortages 7 GW capacity gap in the US; nearly half of 2026 planned projects delayed or canceled. U.S. AI Data Center Delays: 7 GW Capacity Crisis [2026]
Power Availability Underinvestment in Grid Infrastructure Developers expect power constraints by 2027–2028 due to grid underinvestment. Energy Markets Race to Solve the AI Power Bottleneck
Supply Chain Equipment Shortages Long-lead-time for critical equipment like transformers and switchgear. Gridlocked: Power Constraints Shape the Future of Data …
Grid Stability Strain on Real-Time Grid Balancing Introduces risks of voltage and frequency deviations. (PDF) Technical Challenges of AI Data Center Integration …
Project Viability Customer Project Cancellation Utilities face risks of data center customers canceling projects after grid investments are made. Extracting Profits from the Public: How Utility Ratepayers …
