Please login to bookmark Close

Data Center Demand Reshapes Utility Hydrogen Strategy for 2026

Hydrogen Adoption Shifts from Pilots to Hydrogen-Ready Infrastructure

Utility adoption of hydrogen is shifting from small-scale blending pilots to building large, hydrogen-capable fossil fuel infrastructure as a defensive measure against soaring grid demand. This change marks a pragmatic pivot where immediate grid reliability, driven by explosive growth in energy-intensive sectors like data centers, is prioritized over direct investment in near-term green hydrogen production. The strategy is not a retreat from decarbonization but a calculated decision to build optionality into new assets.

  • Between 2021 and 2024, the primary focus was on de-risking hydrogen through small, contained pilots. Dominion Energy initiated projects to test a 5% hydrogen blend in its existing natural gas networks in Ohio and Utah, gathering data on infrastructure compatibility and safety without significant capital outlay.
  • Starting in 2025, the strategy evolved toward infrastructure enablement. The company proposed the $1.47 billion, 1-GW Chesterfield Energy Reliability Center (CERC), a natural gas plant designed with turbines capable of burning up to 10% hydrogen. This represents a move to secure dispatchable power for its Virginia service territory, home to a massive data center cluster.
  • This cautious approach is officially codified in regulatory filings. Dominion Energy’s 2025 Integrated Resource Plan (IRP) for South Carolina explicitly states that green hydrogen is “not a selectable candidate resource” because of its high costs and uncertain commercial availability, confirming that near-term production is not considered economically viable.
Fossil Fuels Dominate Current Hydrogen Production

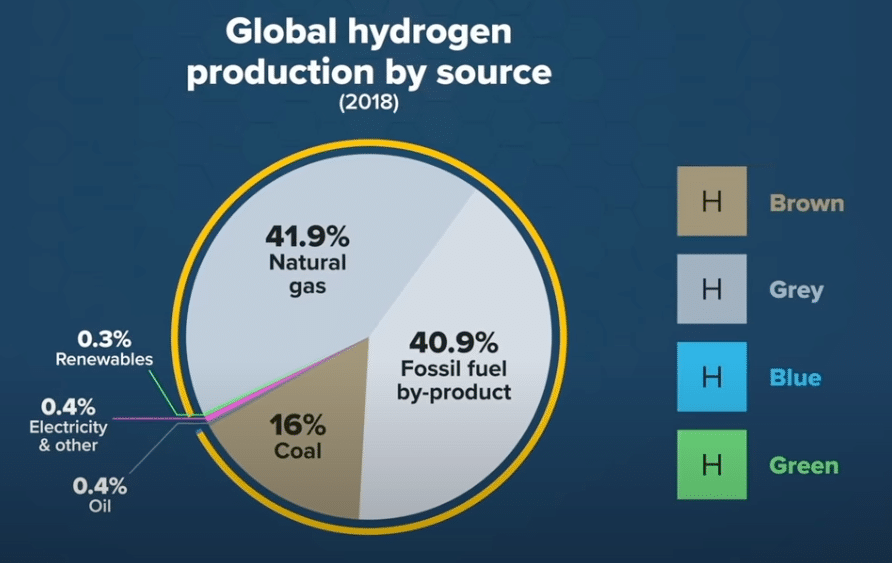

Fossil Fuels Dominate Current Hydrogen Production

This chart shows that over 99% of hydrogen is currently produced from fossil fuels, contextualizing the industry’s pragmatic shift toward hydrogen-ready natural gas infrastructure over unproven green hydrogen.

(Source: Energy and Policy Institute)

Investment Focuses on Grid Reliability and Foundational Assets

Capital allocation in 2025 reflects a clear priority on grid modernization and enabling infrastructure, with direct hydrogen production investments remaining speculative and dependent on future economic triggers. The financial strategy is to first build the resilient grid and large-scale renewable generation necessary to support a future hydrogen economy, rather than investing in production facilities prematurely.

Dominion Energy's Capital Plan Prioritizes Grid

Dominion Energy’s Capital Plan Prioritizes Grid

The chart details Dominion’s multi-billion dollar investment plan, aligning with the section’s focus on capital allocation for grid transformation and foundational assets over direct hydrogen production.

(Source: Natural Gas Intelligence)

  • Dominion Energy committed to a $50 billion capital plan for 2025-2029, with approximately 80% aimed at grid upgrades and new generation resources. This foundational spending is essential to accommodate rising demand and integrate the massive influx of renewable power required for any future green hydrogen initiative.
  • The most significant hydrogen-related investment is the proposed $1.47 billion for the Chesterfield Energy Reliability Center. This project is fundamentally a natural gas bridge, built to ensure grid stability but engineered with the flexibility for partial decarbonization via hydrogen blending.
  • The successful commissioning of the 2.6 GW Coastal Virginia Offshore Wind (CVOW) project, a total investment of approximately $11.5 billion, remains the most critical enabler for green hydrogen. This project, expected to produce power in 2026, will provide the scale of clean electricity needed to make large-scale electrolysis a future possibility.
  • This strategic direction is mirrored by regional competitors. Duke Energy is also advancing a new 1.4 GW power plant in South Carolina designed to burn a blend of natural gas and hydrogen, indicating a broader utility trend of using hydrogen-ready gas turbines as a bridging solution.

Table: Key Hydrogen-Enabling Investments (2025-2029)

Partner / Project Time Frame Details and Strategic Purpose Source
Dominion Energy / 5-Year Capital Plan 2025 – 2029 $50 Billion plan with ~80% for grid upgrades and new energy resources. This is a foundational investment to support rising data center demand and enable future hydrogen integration. Trellis
Dominion Energy / Chesterfield Energy Reliability Center (CERC) 2025 (Proposed) $1.47 Billion for a 1 GW gas-fired plant with turbines capable of burning up to 10% hydrogen. Designed to meet immediate reliability needs while creating future decarbonization options. Virginia Business
Dominion Energy / Coastal Virginia Offshore Wind (CVOW) 2026 (Completion) Total project cost of ~$11.5 Billion for 2.6 GW of offshore wind capacity. It is the primary enabler for future large-scale green hydrogen production. Politico Pro
Duke Energy / Gas-Hydrogen Power Plant 2025 (Advancing) Development of a new 1.4 GW power plant in South Carolina designed to utilize natural gas and hydrogen, showing a regional trend toward hydrogen-ready thermal assets. POWER Magazine

Partnerships Target Technology Acquisition and Early-Stage Hubs

Strategic partnerships in 2025 are focused on securing hydrogen-capable technology and participating in federally-backed, early-stage regional hub planning rather than signing commercial offtake agreements for hydrogen supply. This collaborative approach allows utilities to gain technical expertise and influence market development with minimal upfront capital risk, positioning them to be key players if and when the hydrogen economy matures.

  • Between 2021 and 2024, partnerships centered on broad, exploratory coalitions. Dominion Energy became a founding member of the Southeast Hydrogen Hub and a key partner in the Appalachian Regional Clean Hydrogen Hub (ARCH 2), which was later selected for up to $925 million in DOE funding.
  • In 2025, partnerships became more technologically specific. The collaboration with GE Vernova, which saw the first commercial operation of its hydrogen-capable LM 6000 VELOX turbine at a Dominion Energy facility, is a key move to secure proven technology for future-proofing thermal assets.
  • Participation in the Southwest Virginia Hydrogen Hub planning initiative, which received $750, 000 in state grants in late 2025, demonstrates a continued strategy of low-cost engagement to shape the development of local hydrogen ecosystems.
  • Long-term, non-financial collaborations, such as the one with Commonwealth Fusion Systems for a future commercial fusion plant, highlight a vision for leveraging breakthrough energy sources that could one day power green hydrogen production at an immense scale.

Table: Strategic Hydrogen Partnerships and Collaborations

Partner / Project Time Frame Details and Strategic Purpose Source
Virginia Energy, GTI Energy, et al. / Southwest Virginia Hydrogen Hub Dec 2025 Participation in a regional hub planning initiative awarded $750, 000 in grants to survey industries and deploy demonstration infrastructure, securing a role in early-stage ecosystem development. Virginia Clean Cities
GE Vernova / LM 6000 VELOX Deployment Feb 2025 Deployed the first commercial unit of GE Vernova’s advanced, hydrogen-capable gas turbine, securing access to and operational experience with key flexible generation technology. GE Vernova
Commonwealth Fusion Systems (CFS) / Fusion Plant Collaboration Jan 2025 A non-financial collaboration to support the development of a commercial fusion plant in Virginia, positioning to leverage a potential long-term source of abundant clean energy for hydrogen production. Fusion Energy Insights
Battelle, Air Liquide, et al. / ARCH 2 Hub Oct 2023 Became a key development partner in the ARCH 2 hub, selected for up to $925 million in DOE funding to produce blue hydrogen from natural gas, leveraging federal subsidies to de-risk entry. Battelle

Geography of Hydrogen Activity Concentrates in Virginia

Hydrogen-related activity is concentrating in regions with both significant industrial demand and acute grid constraints, with Virginia emerging as the epicenter of capital deployment. The state’s massive and growing data center alley creates a unique and urgent pull for dispatchable, decarbonization-optional power, reshaping investment priorities away from geographically diverse pilots toward targeted, large-scale infrastructure projects.

Virginia's Rising Energy Generation Creates Demand

Virginia’s Rising Energy Generation Creates Demand

This chart illustrates the significant increase in Virginia’s overall energy generation, underscoring the grid constraints and demand pull that make the state an epicenter for new hydrogen-related infrastructure.

(Source: Fairfax County)

  • From 2021 to 2024, hydrogen activities were geographically dispersed, with small-scale blending pilots taking place in Utah (Therm H 2 project) and a dedicated test facility in Ohio (Hydrogen Heights), reflecting a broad exploratory phase.
  • In 2025, the strategic focus sharpened dramatically on Virginia. The proposal for the 1-GW CERC project in Chesterfield County is a direct response to the voracious energy demand from data centers concentrated in the state.
  • While collaborative planning continues in multi-state regions like the Appalachian area for the ARCH 2 hub (involving West Virginia, Ohio, Pennsylvania) and the broader Southeast, Virginia is where major capital is being allocated for new “hydrogen-ready” generation assets.

Hydrogen Technology Focus Matures to Power Generation Turbines

While low-concentration hydrogen blending is now operationally proven, the core technology focus for utilities in 2025 has matured to the commercial deployment of “hydrogen-ready” gas turbines. This technology is established for low blends (up to 10-30%), but its economic and operational viability for the high blends needed for deep decarbonization remains unproven at large scale, making it a transitional solution.

  • The 2021-2024 period successfully validated the technical feasibility of blending 5% hydrogen into existing gas distribution networks without significant adverse effects on pipelines or end-use appliances, as shown by Dominion’s pilots.
  • By 2025, the technology frontier for utilities shifted from distribution to power generation. The key focus is now on acquiring and deploying turbines, like those from GE Vernova, that can co-fire hydrogen, allowing new natural gas plants to serve as a bridge to a lower-carbon future.
  • Green hydrogen production technology, primarily PEM electrolysis, is commercially available but not yet economically competitive for utility-scale deployment. The primary barrier is cost, not technical readiness, which is why it was deemed “not a selectable candidate resource” in Dominion’s IRP.
  • Separately, utilities are exploring nascent hydrogen applications like long-duration battery storage. Dominion’s pilot with Ener Venue to deploy a 1.5 MW metal-hydrogen battery system represents a forward-looking effort to test alternative grid-support technologies.

SWOT Analysis of Dominion Energy’s Hydrogen Strategy

Dominion Energy’s primary strength is its regulated asset base, which enables massive, long-term infrastructure investments like the CVOW project. However, its strategy is fundamentally constrained by its regulatory obligation to ensure grid reliability at the lowest reasonable cost, which currently favors proven, dispatchable assets over emerging technologies like green hydrogen.

Dominion's Generation Mix Shows Decarbonization Challenge

Dominion’s Generation Mix Shows Decarbonization Challenge

Dominion’s 2023 reliance on non-renewable and nuclear sources highlights the core challenge its hydrogen strategy must address, which is a key weakness and threat detailed in the SWOT analysis.

(Source: Fairfax County)

  • The company’s opportunities are directly linked to the massive load growth from data centers and the availability of federal incentives for clean energy and hydrogen hubs.
  • Threats include the high and uncertain cost trajectory of green hydrogen, potential regulatory or public opposition to new fossil-fuel infrastructure, and the risk that these “hydrogen-ready” assets become stranded if the hydrogen economy fails to materialize.

Table: SWOT Analysis for Dominion Energy’s Hydrogen Initiatives

SWOT Category 2021 – 2024 2025 – Today What Changed / Resolved / Validated
Strength Leveraged existing natural gas infrastructure for low-cost blending pilots. Established presence in regional hub coalitions (ARCH 2, Southeast). Executing a $50 B capital plan. Deploying first-of-its-kind hydrogen-capable turbine technology (GE Vernova). The ability to finance and execute massive capital projects (like the $11.5 B CVOW) was validated, providing a clear pathway to enabling future green hydrogen.
Weakness Hydrogen strategy was limited to small pilots with no clear path to commercial scale. Dependent on future federal funding for hub projects. Official IRP states green hydrogen is “not a selectable candidate resource” due to high cost. New projects are primarily fossil-fueled (natural gas with H 2 option). The economic infeasibility of large-scale green hydrogen in the near term was formally acknowledged, clarifying the utility’s cautious, gas-dependent bridging strategy.
Opportunity Pursued federal funding from the $7 B DOE H 2 Hubs program. Explored partnerships for low-carbon natural gas supply. Massive data center electricity demand creates a guaranteed offtaker for new dispatchable power. $1.47 B CERC project directly serves this need. The scale of the data center energy crisis in Virginia became the single largest driver of new generation strategy, creating a powerful business case for hydrogen-ready gas plants.
Threat Uncertainty over hydrogen blending’s impact on infrastructure integrity and appliance performance over the long term. Potential for regulatory and public opposition to building new large-scale natural gas infrastructure (CERC). High cost of CVOW project ($11.5 B). The primary risk shifted from the technical feasibility of blending to the financial and political risk of building multi-billion-dollar fossil fuel assets in an era of decarbonization.

2026 Scenario: Grid Reliability Delays Green Hydrogen Production

If data center energy demand continues to outpace renewable energy deployment, watch for utilities to accelerate the permitting of more hydrogen-ready gas plants, solidifying natural gas as a multi-decade bridge fuel and delaying large-scale green hydrogen production until post-2030.

Green Hydrogen Growth Faces Potential Delays

Green Hydrogen Growth Faces Potential Delays

This optimistic forecast for the green hydrogen market provides a stark contrast to the section’s scenario, where grid reliability issues could significantly delay this projected growth.

(Source: CarbonCredits.com)

  • If This Happens: State regulators, facing the threat of grid instability, grant swift approval for Dominion Energy’s $1.47 billion Chesterfield Energy Reliability Center, prioritizing dispatchable power over decarbonization purity.
  • Watch This: Other utilities in the PJM Interconnection and the Southeast announce similar gigawatt-scale, hydrogen-ready combined-cycle gas plants, cementing a regional trend of using this bridging strategy to manage soaring load growth.
  • These Could Be Happening: The successful commissioning of the 2.6 GW CVOW project in 2026 will be the next major decision point. Its performance and final levelized cost of energy will determine whether the subsequent tranche of utility investment is directed toward a first-of-a-kind large electrolyzer project or simply more hydrogen-ready gas infrastructure to firm up intermittent wind power. The focus will remain on enabling infrastructure, not immediate production.

Frequently Asked Questions

Why are utilities building new natural gas plants instead of investing directly in green hydrogen?

Utilities are prioritizing immediate grid reliability to meet soaring electricity demand, particularly from data centers. According to Dominion Energy’s 2025 Integrated Resource Plan, green hydrogen is currently “not a selectable candidate resource” due to its high cost and uncertain commercial availability. Therefore, they are building natural gas plants as a reliable “bridge” solution to ensure a stable power supply now.

What does it mean for a power plant to be ‘hydrogen-ready’?

A ‘hydrogen-ready’ power plant is a new natural gas facility built with turbines capable of burning a blend of natural gas and hydrogen. For example, Dominion’s proposed $1.47 billion Chesterfield Energy Reliability Center (CERC) is designed to burn up to 10% hydrogen. This strategy allows utilities to meet current power needs with natural gas while creating the option to partially decarbonize the asset in the future if hydrogen becomes economically viable.

What is the main reason for this shift in utility strategy towards hydrogen-ready infrastructure?

The primary driver is the explosive growth in energy consumption from data centers, especially in states like Virginia. This has created an urgent need for new, dispatchable power sources to maintain grid stability. The strategy has shifted from small, exploratory hydrogen pilots to building large-scale, hydrogen-capable gas plants as a defensive measure to handle this massive load growth.

What is the most important project for enabling future green hydrogen production mentioned in the article?

The article identifies the 2.6 GW Coastal Virginia Offshore Wind (CVOW) project as the most critical enabler for future large-scale green hydrogen. This approximately $11.5 billion project, expected to be completed in 2026, will provide the massive amount of clean electricity necessary to power electrolysis for producing green hydrogen, making it a foundational asset for a future hydrogen economy.

Based on this new strategy, when can we expect utilities to start large-scale green hydrogen production?

The article suggests that large-scale green hydrogen production is being delayed until at least post-2030. The current focus is on building the foundational infrastructure—such as grid upgrades, massive renewable projects like CVOW, and hydrogen-ready gas plants—first. The actual investment in large-scale hydrogen production facilities will depend on future economic triggers and the successful build-out of this enabling infrastructure.
