Solar Grid Interconnection, 57 GW Project Backlog, $2 T Queue Costs, and Federal vs. State Conflicts (2025 to 2026)
Grid Bottleneck Risks, Solar Project Delays Amid 57 GW Backlog
While the Trump administration’s reversal of federal clean energy policy has created significant financial headwinds, the more fundamental constraint on U.S. solar growth is now the physical and financial bottleneck of grid interconnection. A backlog of over 57 GW of solar and wind capacity is stalled in grid queues, a problem that persists independently of policy shifts and represents the primary barrier to converting market demand into operational assets.
The Shift from Policy to Physical Constraints
The solar industry’s primary challenge has decisively shifted from securing policy support to obtaining physical grid access. Between 2021 and 2024, growth was propelled by federal incentives like the Inflation Reduction Act, making project viability heavily dependent on navigating subsidy frameworks. Since January 2025, despite policy hostility marked by the “One Big Beautiful Bill Act” (OBBBA), the core issue has become the inability to connect viable projects to the grid. This systemic delay is underscored by reports of a $2 trillion economic cost associated with the national interconnection queue, demonstrating that infrastructure, not just legislation, is now throttling expansion.
Project Viability and Curtailment
The grid bottleneck directly threatens the financial viability of new and existing solar projects, an issue exacerbated by rising energy curtailment. Even when projects clear regulatory and financing hurdles, the lack of grid capacity leads to costly delays and operational inefficiencies. An April 2026 court ruling that blocked the administration’s “clean energy blockade” was a significant legal victory, yet it does not resolve the physical logjam for the 57 GW of cleared projects. Furthermore, exploding curtailment rates mean that even operational assets are forced to waste energy, eroding revenue and disincentivizing investment in congested regions, regardless of favorable local policies or demand.
| Technology⇅ | Market Segment⇅ | LCOE ($/kWh)⇅ | Time Period⇅ | Key Details⇅ | Source⇅ |
|---|---|---|---|---|---|
| Concentrating Solar Power (CSP) | Utility-Scale Solar | 0.12 | Recent | Represents a 70% decline from a high of $0.39/kWh. | Quarterly Solar Industry Update ↗ |
| Hydropower | Utility-Scale Renewables | 0.06 | 2024 | Global weighted average LCOE. | Renewable power generation costs in 2024 ↗ |
| Solar PV | Utility-Scale Solar | 0.04 | 2024 | Global utility-scale LCOE, as reported by IRENA. | Solar Powered Data Center: Economics and Feasibility ↗ |
| Onshore Wind | Utility-Scale Wind | 0.03 | 2024 | Global weighted average LCOE, making it the cheapest source of new electricity. | Renewable power generation costs in 2024 ↗ |
2025 Solar Capacity Forecasts Plummet Under Trump
Projected 2025 solar capacity has plummeted, dropping from a March base case of 274.2 GW to a September low case of 202.4 GW. This 26% decline in forecasts reflects growing policy uncertainty under a potential Trump administration, signaling a substantial pullback in future solar installations.
(Source: SEIA/Wood Mackenzie Power & Renewables — via Chart: Solar Employment Falls For Second Year Under Trump | Statista)
$98.5 B in Cancellations, Federal Fund Pullbacks and Project Revisions
The administration’s strategic pivot away from renewables has resulted in the direct cancellation or revision of over $98.5 billion in clean energy projects and funding, creating immediate and significant disruption for developers. This financial pullback, executed through executive orders, legislative action, and agency directives, has rescinded capital commitments and destabilized project pipelines that were reliant on federal support.
Systematic Termination of Federal Programs
The financial reversal has been systematic, targeting both broad-based tax incentives and specific grant programs. The OBBBA, signed July 4, 2025, officially terminated the 25 D residential solar tax credit and imposed strict deadlines on commercial projects. This was compounded by the abrupt cancellation of the $7 billion Solar for All grant program in August 2025 and the rescinding of community solar funds in places like Puerto Rico in January 2026. These actions removed foundational financial support mechanisms that the industry had integrated into its growth models.
Targeted Funding Cuts and Revisions
Beyond broad legislative changes, the administration has actively intervened to halt specific projects and re-allocate funds. This includes the cancellation or revision of over $83 billion in loans and loan guarantees across more than 30 states. The Department of Energy also canceled over $13 billion in unobligated funds in September 2025, followed by an additional $7.5 billion cut that largely targeted projects in Democratic-led states. In a more direct move, by August 2026, the administration had committed nearly $4 billion to actively persuade energy companies to cancel planned power projects.
Table: Federal Clean Energy Project and Funding Cancellations (2025 – 2026)
| Partner / Project | Time Frame | Details and Strategic Purpose | Source |
|---|---|---|---|
| Energy Companies | Aug 2026 | Administration paid nearly $4 billion to persuade companies to actively cancel planned power projects amid a declared energy emergency. | Forbes |
| Community Solar Projects | Jan 2026 | Department of Energy canceled funding for community solar projects in Puerto Rico, reversing a prior commitment. | The San Juan Daily Star |
| Projects in Democratic-Led States | Jan 2026 | During a government shutdown, the DOE cut $7.5 billion in energy spending, largely targeting projects in “blue states.” | The New York Times |
| Department of Energy Programs | Sep 2025 | The DOE canceled over $13 billion in unobligated funds as part of a broader rollback of clean energy initiatives. | U.S. Department of Energy |
| Solar for All Program | Aug 2025 | The Environmental Protection Agency (EPA) abruptly terminated the $7 billion Solar for All grant program. | Sol-Ark |
| Various Clean Energy Projects | Q 1 2025 | Nearly $8 billion worth of projects were canceled in the first three months of 2025 due to policy reversals and tariff uncertainty. | Clean Air Task Force |
| Loan and Loan Guarantee Program | 2025 | The administration canceled or is revising over $83 billion in loans and loan guarantees for projects across more than 30 states. | Pexapark |
| Date⇅ | Policy Action / Impact⇅ | Market Segment⇅ | Financial Value (USD)⇅ | Description⇅ | Source⇅ |
|---|---|---|---|---|---|
| Aug 8, 2026 | Payments to Cancel Projects | Power Generation | Nearly $4 Billion | The administration committed funds to persuade energy companies to cancel planned power projects. | U.S. Declared An Energy Emergency, Then Paid $4 Billion … ↗ |
| Feb 26, 2026 | Loan Revisions & Cancellations | Clean Energy Financing | Over $83 Billion | Value of loans and loan guarantees for projects across 30+ states that have been cancelled or are under revision. | 2025’s Massive Clean Energy Pullback Driven by Trump’s … ↗ |
| Jun 4, 2025 | Q1 2025 Project Cancellations | Battery & Hydrogen | Nearly $8 Billion | Value of projects cancelled in the first three months of 2025, including major battery and hydrogen fuel projects. | Policy Brief: How Tariffs are Undermining U.S. Energy and … ↗ |
| Apr 24, 2025 | Quarterly Cancellations Record | Clean Energy Supply Chains | $6.9 Billion | The highest value of quarterly cancellations on record for clean energy investment. | The State of US Clean Energy Supply Chains in 2025 ↗ |

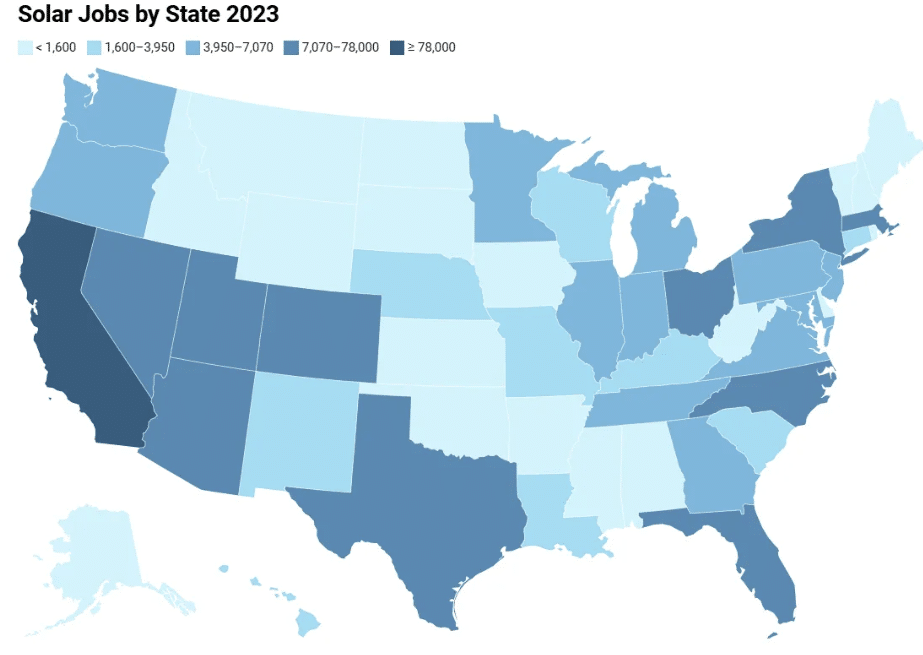

US State-Level Divide, Solar Growth Persists in Pro-Renewable States
Despite a hostile federal environment, the geography of U.S. solar development is fragmenting, with growth now concentrated in states with supportive regulatory frameworks and strong private-sector demand. This bifurcation is creating a distinct divide where state-level policies and corporate procurement from entities like Google are becoming more influential than federal incentives, even as the administration actively targets projects in certain states.
The Bifurcation of State Markets
A clear geographic split in project viability has emerged since January 2025. The administration’s move to cut $7.5 billion in funding for projects predominantly in “blue states” illustrates a strategy of targeted opposition. In response, these states are reinforcing their own renewable portfolio standards and incentives to counteract federal actions. This creates a patchwork market where developers must navigate diverging state-by-state regulatory landscapes, prioritizing regions where state support and clear grid-access rules provide a more stable investment environment.
Corporate Demand as a Geographic Driver
The relentless growth of data centers and corporate sustainability goals is creating powerful, geography-specific demand centers for solar energy that operate independently of federal policy. The need to power AI and cloud infrastructure is leading companies like IBM to secure large-scale renewable energy, driving project development in states with favorable conditions for both data centers and solar farms. This corporate-led demand ensures a durable market for solar, pulling development into specific corridors where industrial power needs are highest, even if federal support is absent.
| Forecast Provider⇅ | Market Segment⇅ | 2024 Market Size ($B)⇅ | 2025 Market Size ($B)⇅ | 2032 Forecast ($B)⇅ | 2034 Forecast ($B)⇅ | CAGR (%)⇅ | Source⇅ |
|---|---|---|---|---|---|---|---|
| Solar PV Market (market.us) | Solar PV | 331.60 | 387.35 * | 1148.62 * | 1566.90 | 16.80 | Solar PV Market Size, Share | CAGR of 16.8% ↗ |
| Persistence Market Research | Solar Energy | 122.04 * | 137.20 | 313.80 | 397.38 * | 12.50 | Solar Energy Market Size, Share & Forecast Analysis, 2032 ↗ |
| Solar Energy Systems (straitsresearch) | Solar Energy Systems | 202.22 * | 227.32 | 524.52 * | 666.73 | 12.41 * | Solar Energy Systems Market Size, Share, Growth … ↗ |
Solar Technology Maturity, Economic Viability Outweighs Policy Risk
The U.S. solar sector’s resilience is anchored in the proven maturity and compelling economics of photovoltaic technology, which now largely insulate it from the volatility of federal policy. While the period from 2021 to 2024 was defined by scaling up deployment with subsidies, the market from 2025 onward is driven by solar’s standalone competitiveness. However, as the industry expands, new constraints are emerging in the supply chain for materials and manufacturing capacity.
LCOE as the Primary Growth Driver
The low and continuously falling Levelized Cost of Energy (LCOE) is the fundamental economic driver that sustains the solar market. By 2026, solar power remains one of the cheapest forms of new electricity generation in many parts of the U.S., even without federal tax credits. This durable cost advantage ensures demand from utilities, corporations, and other large offtakers who are motivated by long-term energy price stability, a factor that federal policy shifts cannot easily undermine.
Emerging Supply Chain and Manufacturing Gaps
With the core technology mature, the industry’s focus is shifting to vulnerabilities in the upstream supply chain. Reports in 2026 highlight an “emerging steel bottleneck” that affects the availability and cost of mounting structures, a critical component for utility-scale projects. Concurrently, a “massive gap between stated capacity and real factory output” in U.S. solar manufacturing suggests that while domestic production is growing, it is not yet sufficient to meet demand or fully mitigate reliance on global supply chains. These infrastructure and industrial-base issues are becoming more critical than the PV technology itself.
| Forecast Provider⇅ | Market Segment⇅ | 2026 Market Size⇅ | 2031 Market Size⇅ | 2035 Market Size⇅ | CAGR (%)⇅ | Source⇅ |
|---|---|---|---|---|---|---|
| Custom Market Insights | Overall Solar Energy | $359 Billion | $770.43 Billion * | $1418 Billion | 16.50 | Global Solar Energy Market Size, Trends, Share 2026-2035 ↗ |
| Precedence Research | Solar Photovoltaic (PV) | $216.04 Billion | $469.61 Billion * | $874.01 Billion * | 16.80 * | Solar Photovoltaic (PV) Market Growth Forecast 2026-2035 ↗ |
| Mordor Intelligence | Solar Energy (Capacity) | 2.92 Terawatts | 7.25 Terawatts | 14.99 * | 19.91 | Solar Energy Market Size & Share Analysis ↗ |
| Time Period⇅ | Market Segment⇅ | Manufacturing Capacity (GW)⇅ | Source⇅ |
|---|---|---|---|
| Q3 2025 | Solar Module | 60.10 | Solar Market Insight Report Q4 2025 – SEIA ↗ |
| Oct 2025 | Solar Cell | 3.20 | Domestic Solar Manufacturing Booms During Trump … ↗ |
| Q2 2024 | Solar Module | 31 | U.S. Solar Manufacturing Capacity: Q2 2024 Analysis ↗ |
| End of 2024 | Solar Cell | 1 | Domestic Solar Manufacturing Booms During Trump … ↗ |
SWOT Analysis, Solar Market Navigates Federal Policy and Grid Limits
The U.S. solar industry’s fundamental strength is its economic competitiveness, which provides a strong buffer against political headwinds. However, this strength is tested by significant external threats from federal policy and internal weaknesses related to grid infrastructure. The key opportunity lies in leveraging state-level support and surging corporate demand to overcome these barriers, turning systemic constraints into a competitive advantage for well-positioned developers.
Table: SWOT Analysis for U.S. Solar Industry
| SWOT Category | 2021 – 2023 | 2024 – 2025 | What Changed / Resolved / Validated |
|---|---|---|---|
| Strengths | Falling LCOE and strong federal support via the Inflation Reduction Act (IRA) created ideal growth conditions. | Mature technology with a highly competitive LCOE makes solar economically viable without subsidies. Strong corporate and state-level demand persists. | The industry’s economic strength was validated as it sustained momentum despite the termination of federal subsidies, proving its competitiveness on market terms. |
| Weaknesses | Growing awareness of interconnection queue delays, but often overshadowed by focus on subsidy capture. Reliance on global supply chains. | Grid interconnection has become the primary bottleneck, with a 57 GW backlog. A “massive gap” is identified between announced and actual U.S. manufacturing output. | The weakness shifted from a manageable delay to a critical structural barrier. The problem of grid access is now more acute than policy uncertainty. |
| Opportunities | IRA incentives for domestic manufacturing and deployment. Growing ESG-driven corporate procurement. | Surging electricity demand from AI and data centers creates new, large-scale offtakers. State-level incentives and RPS goals create resilient regional markets. | The AI-driven energy demand surge emerged as a powerful new market driver, creating opportunities that are independent of federal energy policy. Court wins also provide a path to restore some funding. |
| Threats | Supply chain disruptions (e.g., polysilicon) and potential for future policy shifts. | Direct policy hostility via OBBBA, termination of homeowner tax credits, and cancellation of $98.5 B+ in federal funding and loans. Targeted funding cuts for “blue states.” | The hypothetical threat of policy reversal became a reality. The administration moved from rhetoric to actively paying companies to cancel renewable projects, a new and direct form of opposition. |
| Technology⇅ | Market Segment⇅ | Reported TRL⇅ | Description⇅ | Commercial Timeline⇅ | Source⇅ |
|---|---|---|---|---|---|
| Perovskite Solar Modules | Next-Gen PV | TRL 7 | The LUMINOSITY project has demonstrated flexible perovskite modules with efficiencies over 20% on areas exceeding 900 cm². | LUMINOSITY project demonstrates first flexible perovskite … ↗ | |
| Self-Healing Solar Cells | Advanced Materials | TRL 4-5 | Technology is at the lab/prototype validation stage. | 5-10 years | Self-Healing Solar Cells: Technology, Status & EPC Impact ↗ |
| Solar-Fuel Production (CO2 Reduction) | Solar-to-Fuel | TRL 3-4 | Technology is at the proof-of-concept and lab validation stage. Achieving TRL 6-7 is a key goal for commercial feasibility. | Solar-Fuel Production by Photodriven CO2 Reduction ↗ |
Scenario Modelling, Unlocking 57 GW of Bottlenecked Solar Projects
The primary determinant of U.S. solar growth through 2026 will be the industry’s ability to finance and execute grid upgrades to resolve interconnection bottlenecks. With 57 GW of shovel-ready projects stalled, strategic action on grid infrastructure is more critical than lobbying for a reversal of federal energy policy. Success will be defined by innovative financing and development models that directly address grid constraints.
- If this happens: State governments or private consortiums, frustrated with federal inaction and utility timelines, begin to directly fund and fast-track transmission and substation upgrades to clear their local interconnection queues.
- Watch this: A market-wide increase in Power Purchase Agreements (PPAs) that include specific clauses and financing mechanisms for grid upgrades, effectively shifting the cost and execution risk from utilities to developers and large corporate offtakers like ACWA Power.
- These could be happening: Developers are already prioritizing projects in regions with available grid capacity, even if solar irradiance is suboptimal, leading to new geographic development patterns. This will be paired with a significant rise in co-located battery storage projects designed to mitigate grid impact and improve project economics in congested transmission corridors.
| Date⇅ | Policy / Program⇅ | Market Segment⇅ | Action Taken⇅ | Financial Impact (USD)⇅ | Source⇅ |
|---|---|---|---|---|---|
| Jan 21, 2026 | Community Solar Projects | Community Solar | Funding and cooperative agreements canceled | US Energy Dept. cancels funding for community solar … ↗ | |
| Jan 12, 2026 | Biden-era Energy Spending | General Clean Energy | Cancellation of funds, largely in Democratic-led states | $7.5 Billion | Trump Cuts to Energy Projects in Blue States Were … ↗ |
| Dec 31, 2025 | 25D Federal Solar Tax Credit | Residential Solar | Tax credit for homeowners officially ended | 30% of system cost | Trump and the Fate of the 30% Solar Tax Credit ↗ |
| Dec 18, 2025 | DOE Unobligated Funds | General Clean Energy | Cancellation of unobligated funds from previous administration | Over $13 Billion | THE STATE OF AMERICAN ENERGY: Promises Made, … ↗ |
| Aug 15, 2025 | Solar for All Grant Program | Residential Solar | Program abruptly ended by the EPA | $7 Billion | The Canceled $7 Billion Solar Program – The Fallout | News ↗ |
| Jul 04, 2025 | One Big Beautiful Bill (OBBBA) | Commercial & Residential Solar | Signed into law, initiating phase-out of various clean energy credits | Inside Washington’s New Energy Policy ↗ |
