Microsoft SMR Strategy: $1 B Constellation Deal, 6 GW PJM Shortfall, and X-energy PPA (2024 to 2026)
Hyperscaler Nuclear PPAs, Microsoft Securing Baseload for AI Data Centers
Hyperscalers are executing a strategic pivot from exploratory renewable energy procurement to underwriting nuclear power generation, a move driven by the urgent need to secure carbon-free, baseload electricity for AI data centers. This shift from passive investment to active project enablement through long-term Power Purchase Agreements (PPAs) is a direct response to looming regional power deficits and grid instability. These firms are now the key enablers making new and previously uneconomical nuclear projects bankable.
From Exploration to Execution
The period between 2021 and 2024 was characterized by smaller, exploratory investments in advanced nuclear technologies, reflecting a learning phase for tech companies. The strategic posture shifted dramatically from 2025 to today. Companies like Microsoft and Amazon are now in an execution phase, using their balance sheets to underwrite gigawatt-scale projects. This is no longer about portfolio diversification or ESG goals; it is an offensive strategy to secure critical infrastructure for future growth and mitigate exposure to volatile electricity markets.
De-risking Capital-Intensive Projects
The primary mechanism for this shift is the use of long-term, credit-backed offtake agreements. By guaranteeing revenue for up to 20 years, big tech’s corporate PPAs provide the financial certainty required to fund the high capital costs of both restarting mothballed plants and building new Small Modular Reactors (SMRs). This effectively creates a new financing model for nuclear power, where the end-user, rather than a regulated utility or government body, de-risks the investment.
| Forecast Provider⇅ | Market Segment⇅ | 2025 Market Size ($B)⇅ | 2026 Market Size ($B)⇅ | 2032/2033 Forecast ($B)⇅ | 2035 Forecast ($B)⇅ | CAGR (%)⇅ | Source⇅ |
|---|---|---|---|---|---|---|---|
| Market Research Future | Small Modular Reactor | 5.62 | 6.34 | 14.73 * | 18.76 | 12.80 * | Small Modular Reactor Market (2026 – 2035) ↗ |
| Persistence Market Research | Small Modular Reactor | 5.80 | 6.29 * | 10.30 | 12.13 * | 8.50 | Small Modular Reactor Market Size & Growth Trends, 2032 ↗ |
| Skyquestt | Small Modular Reactor | 8.17 | 8.90 * | 16.16 | 19.16 * | 8.90 | Small Modular Reactor Market Size | Growth Report [2033] ↗ |
$1 B Federal Loan, Microsoft PPA to Revive Nuclear Assets
Recent financial commitments, including direct hyperscaler PPAs and supportive federal loans, demonstrate a powerful new public-private financing model that makes previously uneconomical nuclear projects viable. These transactions are not just investments in a technology but are foundational to building a private, reliable power supply for AI infrastructure, insulating tech giants from public grid failures.
Public-Private Financing Model
The restart of Three Mile Island Unit 1 is a primary example of this new model. Microsoft’s 20-year, 835 MW PPA with Constellation Energy provided the commercial foundation for the project. This was subsequently supported by a $1 billion federal loan to Constellation in November 2025 from the Department of Energy, illustrating how corporate commitments can unlock public financing to resurrect critical energy assets.
SMR Commercialization Capital
Capital is also flowing directly to SMR developers, led by their primary future customers. Amazon took a lead role in capitalizing SMR developer X-energy, headlining a $500 million investment round in October 2024. This direct financial stake, combined with a massive offtake Mo U, ensures X-energy has the capital to scale manufacturing and navigate the costly licensing and construction process, culminating in its successful $1.02 billion IPO in April 2026.
Table: Key Nuclear Financing and Offtake Agreements (2024-2026)
| Partner / Project | Time Frame | Details and Strategic Purpose | Source |
|---|---|---|---|
| X-energy | Apr 2026 | Completed a $1.02 billion IPO with a $2.1 billion valuation. The offering was strongly supported by Amazon’s backing, validating the commercial model of SMRs for data center power. | Tech-Insider |
| Microsoft / Constellation Energy | Nov 2025 | The Trump administration’s DOE provided a $1 billion loan to Constellation Energy to support the restart of Three Mile Island Unit 1, a project underwritten by a PPA with Microsoft. | Tech Crunch |
| Amazon / X-energy | Oct 2024 | Amazon led a $500 million investment round in X-energy and is a key offtaker, securing a future power source for its data centers. This aligns with Amazon’s other nuclear agreements with Talen Energy. | Utility Dive |
| Microsoft / Constellation Energy | Sep 2024 | Signed a 20-year, 835 MW PPA to offtake power from the restarted Three Mile Island Unit 1. The agreement makes the project bankable and secures long-term, carbon-free baseload power for Microsoft’s data centers. | S&P Global |
| Company⇅ | Market Segment⇅ | Partner / Target⇅ | Technology / Asset⇅ | Announced Capacity / Value⇅ | Contract Type / Stage⇅ | Date⇅ | Source⇅ |
|---|---|---|---|---|---|---|---|
| Meta | Nuclear Power | Vistra, TerraPower, Oklo | Existing plants, SMRs | Up to 6.6 GW by 2035 | PPA & Development Agreements | Jan 2026 | Why Are US Data Centers Turning to Nuclear Power, and … ↗ |
| Microsoft | Nuclear Power | Constellation Energy | Three Mile Island Unit 1 (Restart) | 835 MW | 20-Year PPA (Execution) | Sep 2024 | Nuclear power for AI: inside the data center energy deals – Introl ↗ |
| Microsoft | Fusion Power | Helion | Fusion Energy | Min. 50 MW by 2028 | PPA (Exploration) | May 2026 | Data Center Loads and Grid Decarbonization: A Case for … ↗ |
| Amazon | SMR Technology | X-energy | SMR Development (XE-100) | $500M Investment / >5 GW MoU | Strategic Investment (Execution) | Late 2025 | Why Google’s Intersect Acquisition Kills the PPA Era ↗ |
| Renewable Energy | Intersect Power | Solar + Storage Projects | 4.75 | M&A (Vertical Integration) | Dec 2025 | Google’s $4.75B Intersect Acquisition | Introl Blog ↗ | |
| SMR Technology | SMRs | Up to 500 MW | Order (Execution) | Jan 2026 | Nuclear power for AI: inside the data center energy deals – Introl ↗ |
Microsoft Nuclear Partnerships, 5.1 GW Amazon Mo U with X-energy (2024 to 2026)
Strategic alliances are forming not just between tech giants and reactor developers but across the entire global supply chain. These partnerships indicate a coordinated effort to secure manufacturing capacity, fuel supply, and deployment expertise, moving beyond single-project deals to programmatic, multi-gigawatt commitments that can support the exponential growth of AI infrastructure.
Hyperscaler-Developer Alliances
The foundational partnerships are between the power consumers and the technology providers. Microsoft’s deal with Constellation Energy leverages an established operator’s expertise to bring an existing asset online quickly. In contrast, Amazon’s partnership with X-energy is a bet on next-generation technology, actively shaping the SMR market by providing the bankable offtake needed for first-of-a-kind commercial deployment.
International Supply Chain Integration
A significant development is the globalization of the SMR supply chain driven by U.S. hyperscaler demand. The Memorandum of Understanding (Mo U) between Amazon, X-energy, Korea Hydro & Nuclear Power (KHNP), and Doosan Enerbility to deploy up to 5.1 GW of SMRs by 2039 is a key signal. This alliance combines U.S. reactor design with South Korea’s established nuclear manufacturing and construction capabilities, creating a resilient, international supply chain to meet domestic U.S. power demand.
Table: Strategic Nuclear Partnerships for AI Power
| Partner / Project | Time Frame | Details and Strategic Purpose | Source |
|---|---|---|---|
| Amazon / X-energy / KHNP / Doosan | Aug 2025 | Signed an Mo U to collaborate on the global deployment of up to 64 of X-energy’s 80 MW Xe-100 reactors, totaling 5.1 GW, by 2039. This integrates U.S. design with South Korean manufacturing for large-scale deployment. | Yahoo Finance |
| Microsoft / Constellation Energy | Sep 2024 | Partnership to restart Three Mile Island Unit 1, backed by a 20-year PPA. This alliance leverages an experienced operator to bring a proven, large-scale nuclear asset back online to power data centers. | Market Scale |
| Google / Kairos Power | Oct 2024 | Google signed an agreement with advanced reactor developer Kairos Power to collaborate on integrating nuclear technology with data centers and developing a clean energy campus. |
| Date⇅ | Company⇅ | Partner(s)⇅ | Technology / Project⇅ | Capacity Commitment (GW)⇅ | Contract / Deal Type⇅ | Source⇅ |
|---|---|---|---|---|---|---|
| Jan 9, 2026 | Meta | Vistra, TerraPower, Oklo | Existing plant PPAs & new SMR/Advanced Reactor development | 6.60 | 20-Year PPAs & Development Agreements | Why Are US Data Centers Turning to Nuclear Power, and … ↗ |
| Aug 26, 2025 | Amazon | X-energy, KHNP, Doosan | Xe-100 SMR Fleet Deployment | 5.12 * | Memorandum of Understanding (MoU) | X-energy, Amazon, KHNP and Doosan enter MoU for … ↗ |
| Sep 20, 2024 | Microsoft | Constellation Energy | Three Mile Island Unit 1 Restart | 0.83 | 20-Year Power Purchase Agreement (PPA) | How Big Tech’s energy buying affects every enterprise ↗ |
| Oct 14, 2024 | Kairos Power | Advanced Reactor Fleet Development | 0.50 | Master Plant Development Agreement | New nuclear clean energy agreement with Kairos Power ↗ |
PJM Grid Constraints, Microsoft Nuclear Strategy in Pennsylvania
Hyperscaler nuclear activity is concentrating in grid-constrained regions with high data center density and existing nuclear infrastructure, particularly the PJM Interconnection. Projected power shortfalls create a clear business case for securing private power generation, transforming regional grid weaknesses into a strategic driver for corporate nuclear investment.
Focus on PJM Interconnection

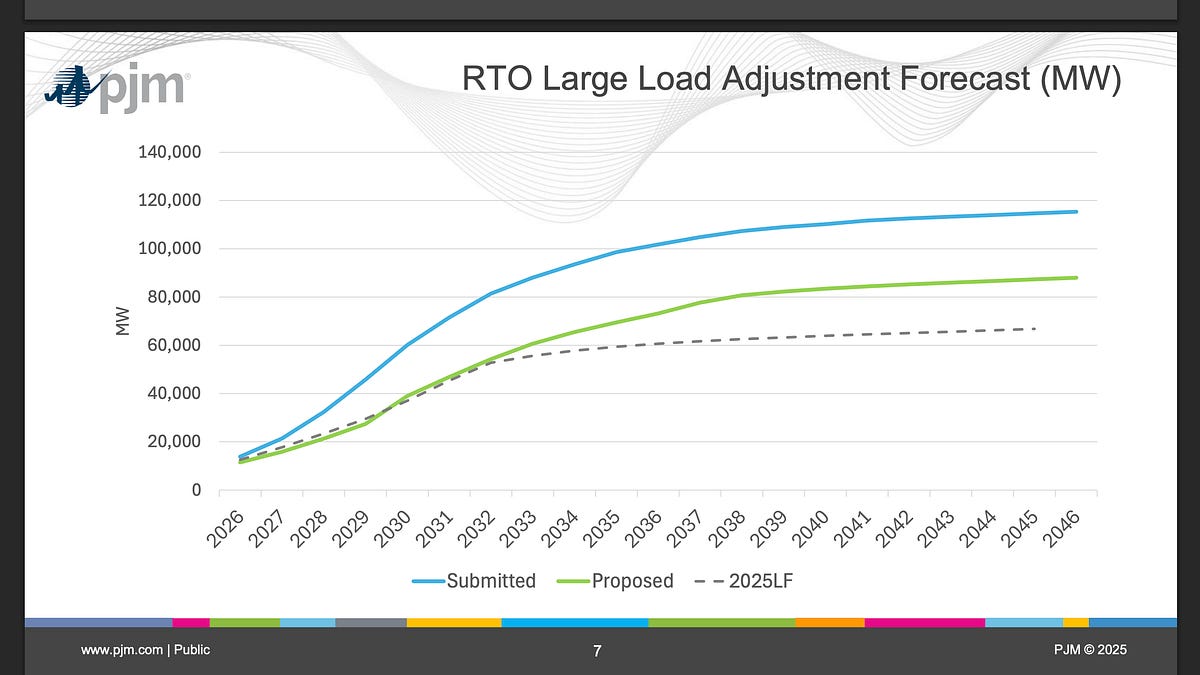

PJM, the grid operator for 13 states including Virginia and Pennsylvania, has become a focal point for these deals due to its massive data center load and projected energy deficits. The operator forecasts a 6 GW power shortfall by 2027, driven almost entirely by new data center demand. This systemic risk makes reliance on the public grid untenable for hyperscalers with high-reliability needs, forcing them to procure their own baseload power. This directly influences the strategy of utilities in the region, including Dominion Energy.
Reviving Dormant Nuclear Assets
The strategy of restarting mothballed nuclear plants is geographically targeted to address these specific regional shortfalls. Microsoft’s deal to revive Three Mile Island in Pennsylvania places a large, reliable, carbon-free generation source directly inside the constrained PJM territory. This is a much faster and lower-risk approach than building a greenfield plant, providing gigawatt-scale power within a few years to meet urgent demand from AI infrastructure in the region.
SMR Commercialization, Microsoft & Amazon backing X-energy’s $1.02 B IPO
Small Modular Reactor technology has matured from the design and licensing phase to a bankable, commercial-scale execution stage. This transition is directly validated by hyperscaler offtake agreements that provide the financial certainty required for first-of-a-kind (FOAK) deployments and successful entry into public capital markets.
SMR Bankability Achieved
The critical change for SMRs between 2021-2024 and today is the shift from technically promising to financially bankable. In the earlier period, SMR developers relied heavily on government grants and demonstration projects, with commercial viability remaining uncertain. Today, long-term PPAs from corporations like Amazon and Microsoft serve as the collateral needed to secure project financing, solving the primary barrier to commercial deployment.
Validation Through Capital Markets
X-energy’s successful $1.02 billion IPO in April 2026 marks a major validation point for the entire SMR sector. Public market acceptance was heavily reliant on the credibility provided by Amazon’s investment and offtake commitments. This success demonstrates a clear path to market for other SMR developers with strong corporate backing. The move is further supported by tangible supply chain progress, such as X-energy beginning construction of its TRISO fuel facility in November 2025, signaling a shift from design to manufacturing.
| Forecast Provider⇅ | Market Segment⇅ | 2024 Market Size ($B)⇅ | 2030 Market Size ($B)⇅ | 2035 Market Size ($B)⇅ | CAGR (%)⇅ | Source⇅ |
|---|---|---|---|---|---|---|
| Market Research Future | Small Modular Reactor | 4.99 * | 10.27 * | 18.76 | 12.80 | Small Modular Reactor Market (2026 – 2035) ↗ |
| Mordor Intelligence | Small Modular Reactor (Capacity) | 23.90 | Small Modular Reactor Market Size & Share Analysis 2030 ↗ | |||
| Market.us | Small Modular Reactor | 5.50 | Small Modular Reactor Market Size, Share | CAGR of 5.5% ↗ | |||
| Maximize Market Research | Small Modular Reactor | 6.08 | 7.82 | 9.15 * | 3.20 * | Small Modular Reactor Market Size, Share & Competitive … ↗ |
| MarketsandMarkets | Small Modular Reactor | 6 | 7.14 | 8.28 * | 3 | Small Modular Reactor Market Report [292 Pages & 268 … ↗ |
SWOT Analysis for Hyperscaler Nuclear Strategy, Microsoft & X-energy
The primary strength of the hyperscaler nuclear strategy lies in leveraging corporate balance sheets to underwrite and de-risk capital-intensive energy projects. This creates a significant first-mover advantage. However, the strategy remains exposed to external threats from complex regulatory processes and public perception, while the immense power demand from AI creates a substantial market opportunity for developers who can execute.
Table: SWOT Analysis for Hyperscaler Nuclear Strategy
| SWOT Category | 2021 – 2023 | 2024 – 2026 | What Changed / Resolved / Validated |
|---|---|---|---|
| Strengths | Exploratory CVC investments in nuclear tech; large balance sheets but limited direct application. | Using balance sheets to sign 20-year PPAs (e.g., Microsoft/Constellation) that make nuclear projects bankable and de-risk construction. | The strategic purpose of capital shifted from learning (exploration) to securing physical gigawatts (execution), turning financial strength into a tangible infrastructure advantage. |
| Weaknesses | Lack of in-house nuclear operational expertise; reliance on intermittent renewables (solar/wind) that are a poor fit for 24/7 data center loads. | Dependence on a small number of nuclear operators (e.g., Constellation) and SMR developers (e.g., X-energy), creating potential partner concentration risk. | Hyperscalers have mitigated a core weakness (energy mismatch) by securing baseload nuclear power. However, this has created a new dependency on the nuclear supply chain’s ability to deliver. |
| Opportunities | Potential to secure clean, firm power to meet future AI demand and achieve carbon goals. | Lock in long-term electricity prices below volatile market rates; revive dormant assets (Three Mile Island); shape the emerging SMR market through strategic partnerships (Amazon/X-energy). | The opportunity moved from theoretical to actionable. The projected 6 GW PJM shortfall created an urgent, concrete business case that hyperscalers are now actively exploiting to their advantage. |
| Threats | Regulatory delays, high capital costs of new nuclear builds, negative public perception. | Continued regulatory hurdles for SMRs, construction delays, and supply chain bottlenecks for reactor components and specialized fuel (TRISO). | Threats have not been resolved but are now being actively managed. Public-private partnerships (e.g., the $1 B DOE loan) and new federal policies are emerging to mitigate regulatory and financial risks. |
Microsoft 2027 Outlook: Will SMRs Meet AI Power Demand Projections?
If hyperscalers continue to sign multi-gigawatt, long-term PPAs for nuclear projects through 2026, watch for a rapid acceleration in final investment decisions (FIDs) for SMRs and a new wave of applications to restart mothballed reactors. This trend will confirm that corporate procurement has become the central engine of the nuclear resurgence in the United States.
- If this happens: Other major tech companies and data center operators expand beyond solar and wind PPAs to sign their first nuclear offtake agreements, validating the strategy pioneered by Microsoft and Amazon.
- Watch this: A significant increase in applications to the Nuclear Regulatory Commission (NRC) for both SMR construction permits and operating licenses for restarted conventional plants. Also, watch for utilities to announce new nuclear projects explicitly backed by data center PPAs to meet surging 134 GW demand projections.
- These could be happening: A bifurcation of the SMR market, where developers with strong hyperscaler backing like X-energy secure funding and pull ahead, while those without a dedicated offtaker struggle. We may also see utilities propose new rate structures specifically for data centers to fund the grid upgrades needed to accommodate these large, localized power demands.
| Technology⇅ | Metric⇅ | Value Range⇅ | Unit⇅ | Source⇅ |
|---|---|---|---|---|
| SMR Nuclear | CAPEX | 7,000 – 8,000 | USD per kW | Are data centers going nuclear? ↗ |
| SMR Nuclear | LCOE (with IRA subsidy) | 58 – 89 | USD per MWh | Small Modular Reactors: A Realist Approach to the Future … ↗ |
| Conventional Nuclear | LCOE (inflation adjusted) | 90 – 100 | USD per MWh | Nuclear Power in the USA ↗ |
| Data Center PPA | Long-Term Nuclear PPA Price | 80 – 130 | USD per MWh | The $150 Billion Private Grid: How Data Centers Built the … ↗ |
| Hyperscale Data Center | CAPEX | 3.4 – 5.5 | USD Billion (for 100 MW facility) | A Look at the Cost Structure Igniting the AI Boom! ↗ |
Major Hyperscaler Nuclear Projects Delayed Past 2030
Only 1 of 6 announced nuclear power deals involving hyperscalers (totaling 9.8 GW across 13 deals) is projected to deliver power before 2030 (Microsoft/TMI Unit 1 restart). Major projects like Amazon/X-Energy and Meta/TerraPower are not expected to be operational until 2030-2032, despite a “Today (2026)” milestone.
(Source: AVANZA ENERGY — via Uranium Market Outlook | Eagle Nuclear (NASDAQ: NUCL))
